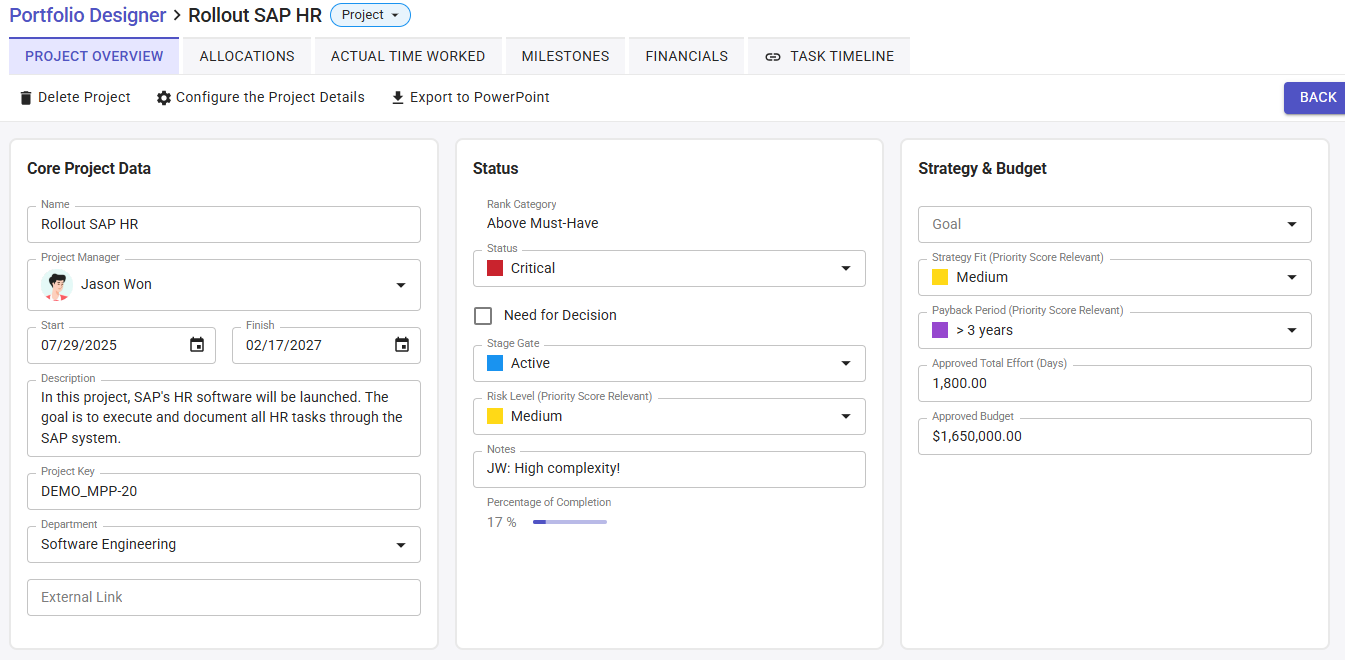

Availability All Editions
In the tabs configured by your organization, you can find project core data, status information and financial details at project level.
Required User Rights
To open and view a project's details, your user group does not need to have specific rights. However, the following rights are required for certain fields, trackers and actions:
- To edit the project's details, your user group needs to have the respective rights under Project & Resource Planning > Projects & Programs:
- Edit Projects and Programs
- Detailed Project and Program Rights
- Project Fields
- To view sections with financial data, you need to have the Access Financial Data right under Views & Areas.
Sections

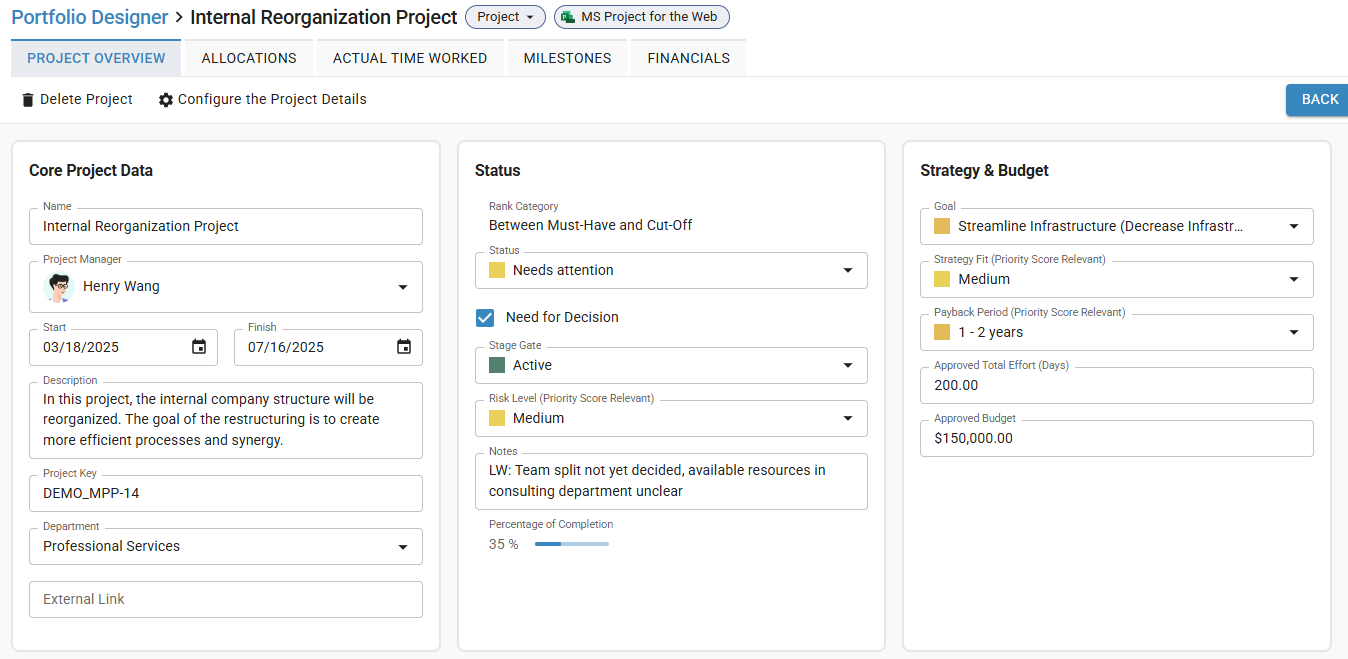

The Project Details can contain up to four configured tabs with project information for Basic Edition systems. You can configure up to 100 tabs in Pro or Premium Edition systems. Additionally, you can find the non-configurable Allocations and Actual Time Worked tabs there, which provides an overview of the resources, teams, and roles allocated to the project. All configurable tabs can contain the following sections.
If you do not have the rights to a project field within a section, you will not see this section. If you do not have the rights to any of the sections in a tab, you will not see the tab.
Toolbar
In the toolbar, you can delete projects or configure the project details for all users.
You can also export project data into a predefined Microsoft PowerPoint template. For more details, see the article Customizing Your Microsoft PowerPoint Template for Project Data Exports.
Custom Sections
You can select from the following fields:
- All project fields for which you have at least read-only rights (system fields and custom fields)
- All Actuals key figures from this listPro Premium
- Financial key figures from this list, displayed in the currency set in the left Sidebar under General SettingsPro Premium
- Top level OBS
- The program name
- Last Changed
- Project Manager
- Business Goal
- Rank Category
- Percentage of Completion
With the respective right, the number, titles and content of the custom sections can be configured. The configuration is a global setting for all users of a Meisterplan system.
To edit project details, simply click the field you'd like to edit.

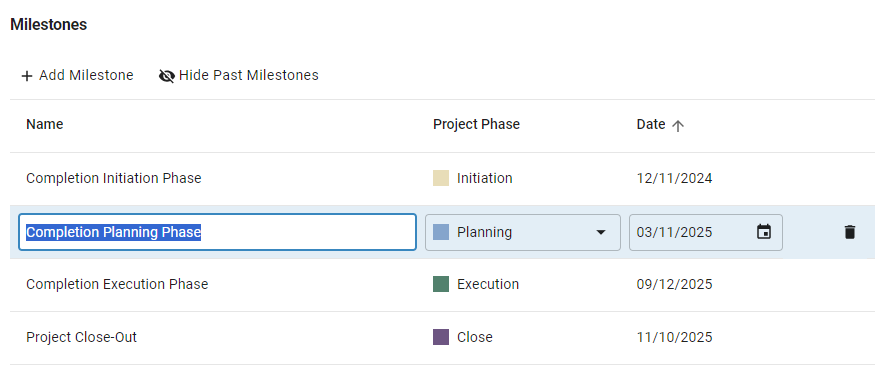

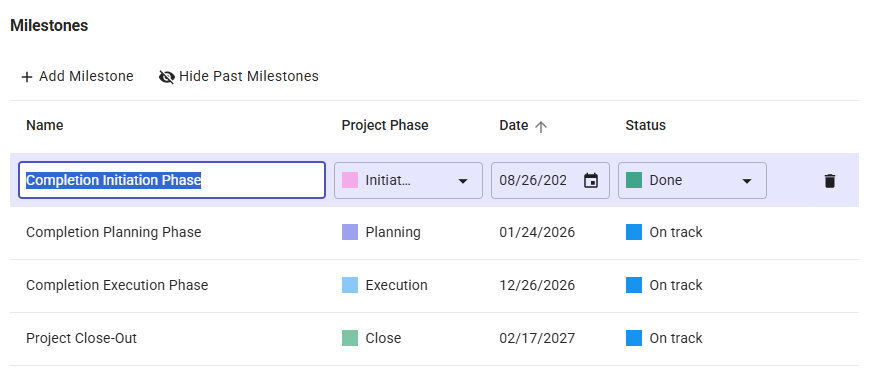

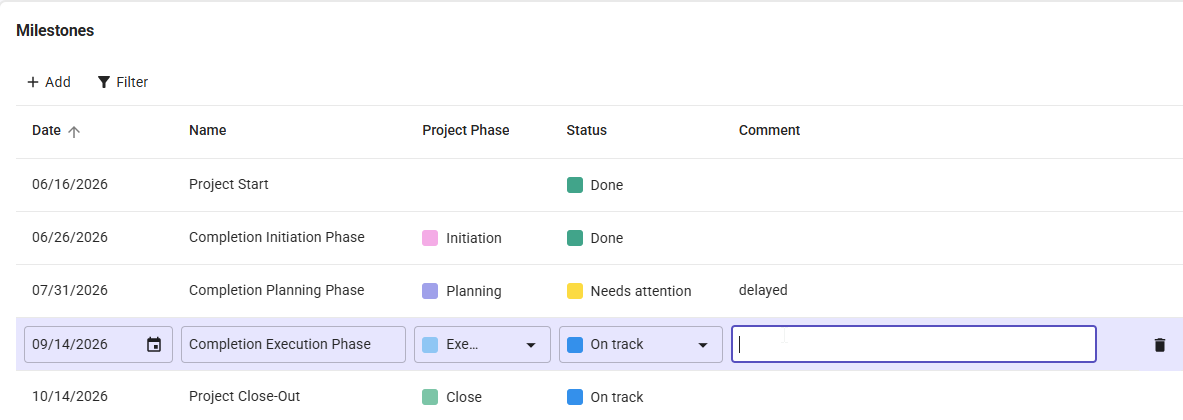

Milestones
In this section, you can see and edit the milestones of your project:
The following information is available for each milestone:
- Name
- Project Phase: Project phases are managed under Manage > Advanced. In the Roadmap and the Portfolio Dashboard, you can filter projects by project phase.
- Date: The milestone date must be within the project phase, and for segmented projects the date must be within a project segment
- Status: Select one of the four pre-defined milestone statuses. In the Roadmap and the Portfolio Dashboard, you can filter projects by their milestone status.
To add a new milestone, click Add Milestone. To delete a milestone, use the trash can icon on the far right.
Additionally, you can edit milestones in the Gantt chart. See the Milestones article for more details.

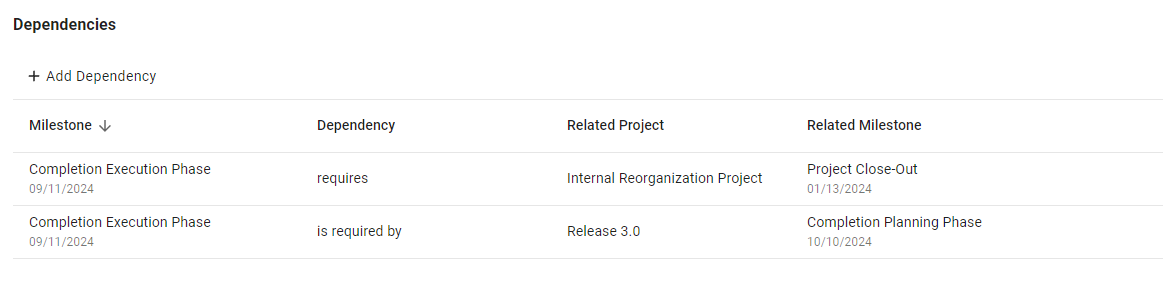

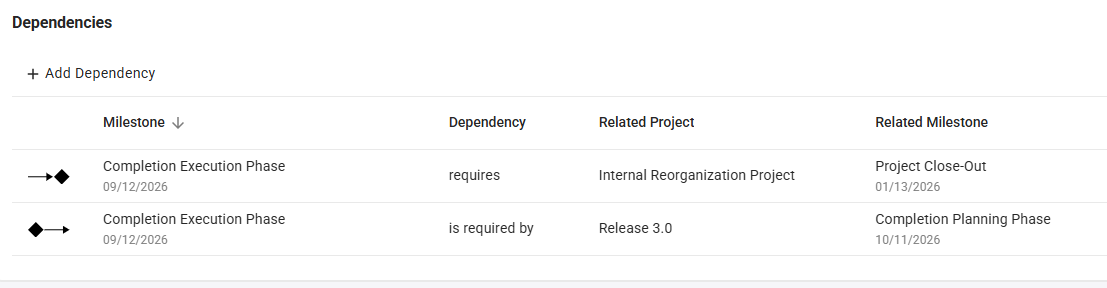

Dependencies
The Dependencies section allows you to add and delete dependencies between milestones on projects.
The following information is available for each dependencies:
- Milestone: The name of the currently selected project's milestone
-
Dependency: The relationship between the currently selected project's milestone and the related milestone
- requires: the milestone on the selected project is the target milestone
- is required by: the milestone on the selected project is the source milestone
- Related Project: the project with the other milestone in the dependency relationship
- Related Milestone: the name of the other milestone in the dependency relationship
To add a new dependency, select Add Dependency. To delete a dependency, use the trash can icon on the far right. Additionally, you can edit dependencies in the Portfolio Designer's Gantt chart. See the Milestones, Project Phases and Dependencies article for more details.
The project filter of the portfolio does not limit the displayed projects; this means that you can select dependencies between milestones of the selected project and other projects that are not in the current portfolio. In other terms, when you want to add a milestone dependency, all projects from the current scenario will be displayed in the dropdown list of the column Related Project.

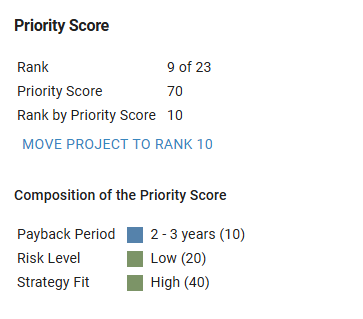

Priority ScorePro Premium
This section contains the following information on the priority score:

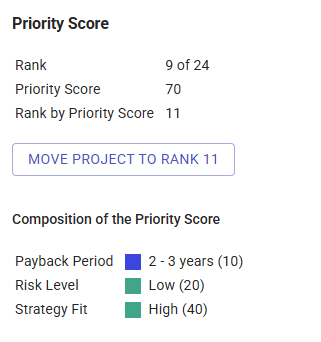

- Rank: The project's current rank in the Portfolio Designer (depends on the currently selected scenario and portfolio)
- Priority Score: The project's score, composed of the values of fields that make up the priority score
- Rank by Priority Score: The project's rank in relation to all other projects. This may, but may not be, the same as the project's current rank.
- Move Project to Rank...: Click this button to move the project to its rank based on its priority score. If the project already has that rank, the button will be disabled.
- Composition of Priority Score: A detailed list of all fields and values that make up the priority score
See the Project Rank and Priority Score article for more details.

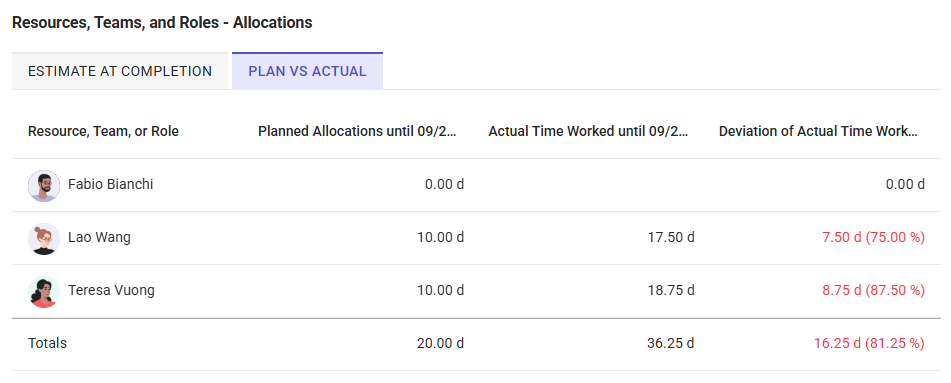

Resources, Teams, and Roles - Allocations
This section displays all resources, teams, and roles that have been assigned to the project with their allocations and Actual Time Worked. You can compare the allocations per resource with the Approved Total Effort and Actual Time Worked. There are two tabs, Estimate at Completion and Plan vs Actual:
Estimate at Completion:

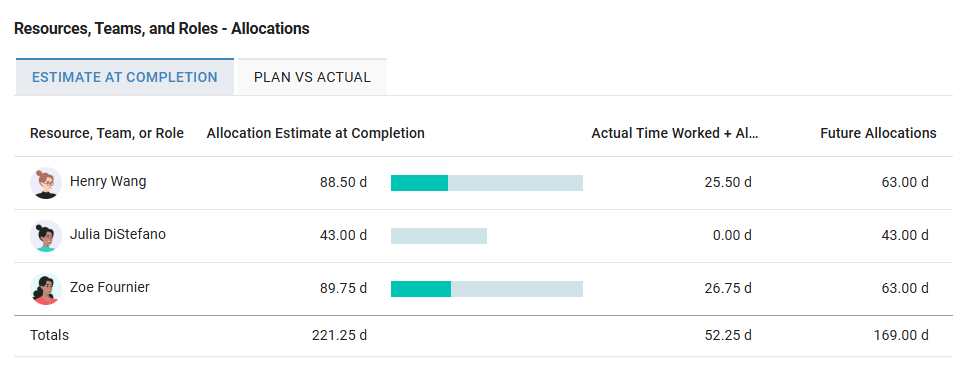

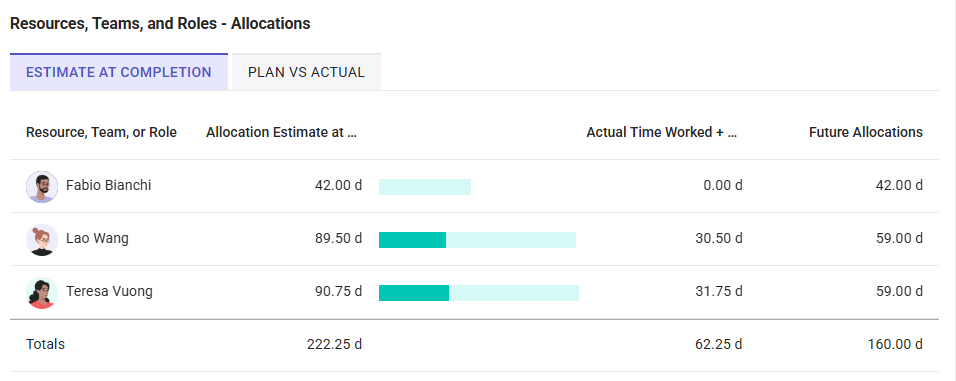

- Resource, Team, or Role: Name of role or resource allocated to this project
- Estimate at CompletionPro Premium: Sum of Actual Time Worked + Allocations until Today and Future Allocations
- Planned Allocations: Sum of all allocations for this project in Meisterplan per resource, role, and team
- Actual Time Worked + Allocations until TodayPro Premium: Actual Time Worked plus planned allocations from the last booking date until today
- Past Allocations: Allocations for this project in Meisterplan from the start of the project until today
- Future Allocations: Allocations for this project in Meisterplan from today until the end of the project
Plan vs ActualPro Premium:

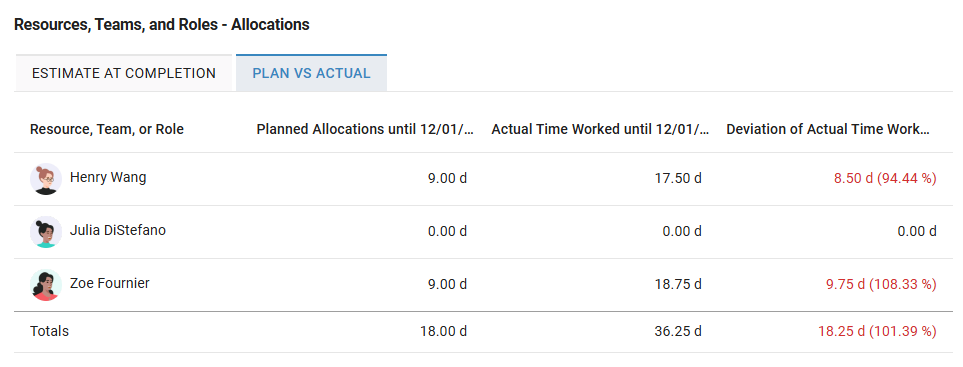

- Planned Allocations: Sum of allocations for the resource, team or role on this project
- Planned Allocations until [last booking date]: Allocations for this resource, team or role and project in Meisterplan until today
- Actual Time Worked until [last booking date]: Sum of imported Actual Time Worked for this project until and including the date mentioned
- Deviation of Actual Time Worked from Planned Allocations: The difference between Actual Time Worked and Planned Allocations, with a positive number indicating that the Actual Time Worked is higher than the Planned Allocations
You can edit allocations, resources, teams, or roles in the Portfolio Designer, or in the Allocations tab of the Project Details. See the Adding and Editing Allocations and the Project Details View (Allocations Tab) articles for more details.
Find more information on Actual Time Worked and related figures in the Actuals - Time Worked article.

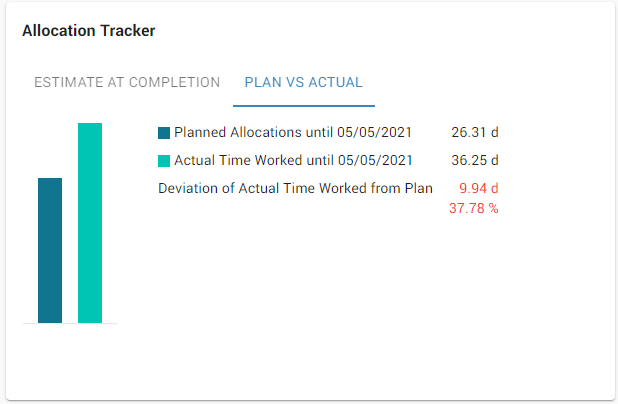

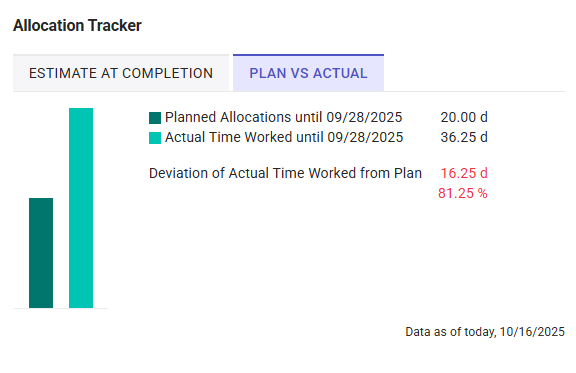

Allocation Tracker
In this section, you can compare the project's allocations with the Approved Total Effort and Actual Time Worked. There are two tabs, Estimate at Completion and Plan vs Actual:
Estimate at Completion:
- Approved Total Effort: The approved effort as entered into the project field of the same name

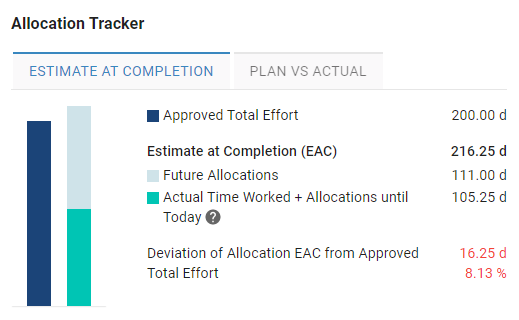

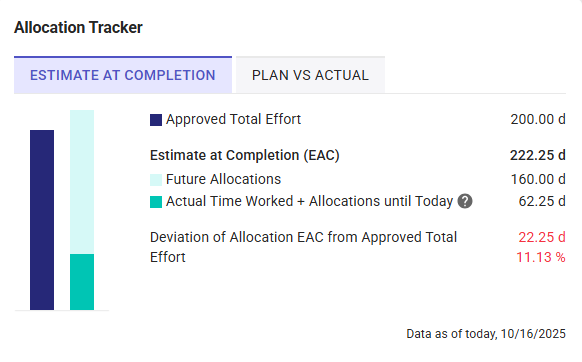

- Allocation Estimate at Completion (EAC)Pro Premium: The sum of Actual Time Worked + Allocations until Today and the Future Allocations
- Planned Allocations: Sum of all allocations for this project in Meisterplan per resource, team, and role
- Past Allocations: Allocations for this project in Meisterplan from the start of the project until today
- Future Allocations: Allocations for this project in Meisterplan from today until the end of the project
- Actual Time Worked + Allocations until TodayPro Premium: Actual Time Worked plus planned allocations from the last booking date until today
- Deviation of EAC from Approved Total EffortPro Premium: The difference between the Allocation Estimate at Completion and the Approved Total Effort, with a positive number indicating that the EAC is higher than the Approved Total Effort
- Deviation of EAC from Planned Allocation Total: The difference between the Allocation Estimate at Completion and the Allocation Total, with a positive number indicating that the EAC is higher than the Allocation Total
- Deviation of Planned Allocations Total from Approved Total Effort: The difference between the Planned Allocations Total and the Approved Total Effort displayed in time unit or percent, with a positive number indicating that the Planned Allocations Total is higher than the Approved Total Effort
Plan vs. ActualPro Premium:
- Planned Allocations until [last booking date]: The sum of allocations in Meisterplan for this project until and including the date mentioned
- Actual Time Worked until [last booking date]: The sum of imported Actual Time Worked for this project until and including the date mentioned
- Deviation of Actual Time Worked from Planned Allocations: The difference between Actual Time Worked and Planned Allocations, with a positive number indicating that the Actual Time Worked is higher than the Planned Allocations
Find more information on Actual Time Worked and related figures in the Actuals - Time Worked article.
Resources, Teams, and Roles - Billing RatesProPremium
In this section, you can define billing rates for resources, teams, and roles. These are taken into account when calculating the allocation benefit and the total benefit.
In the section's toolbar, click Apply Standard Billing Rates to apply the standard billing rates entered in in the Resource Pool to each resource, team, or role. This will overwrite all previously entered billing rates in the project. You can always change the billing rates.
- Resource, Team, or Role: Name of the resource, team, or role allocated to that project; for each resource, their primary role is also displayed as a separate entry.
- Billing Rate per Hour: Enter the billing rate. When you enter a billing rate for a role, it is automatically applied to to all resources and teams with this primary role. Applied billing rates will be displayed in gray.
- Allocation EAC: The sum of Actual Time Worked + Allocations until Today and the Future Allocations
- Allocation Benefit EAC: Allocation EAC x Billing Rate

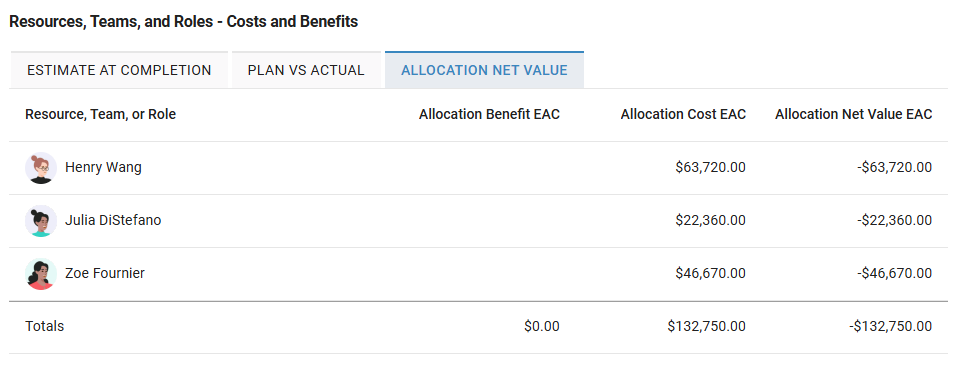

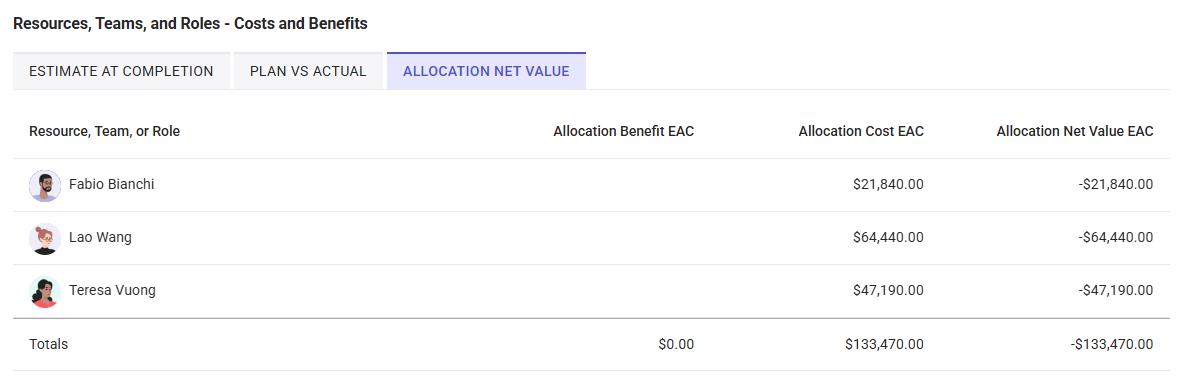

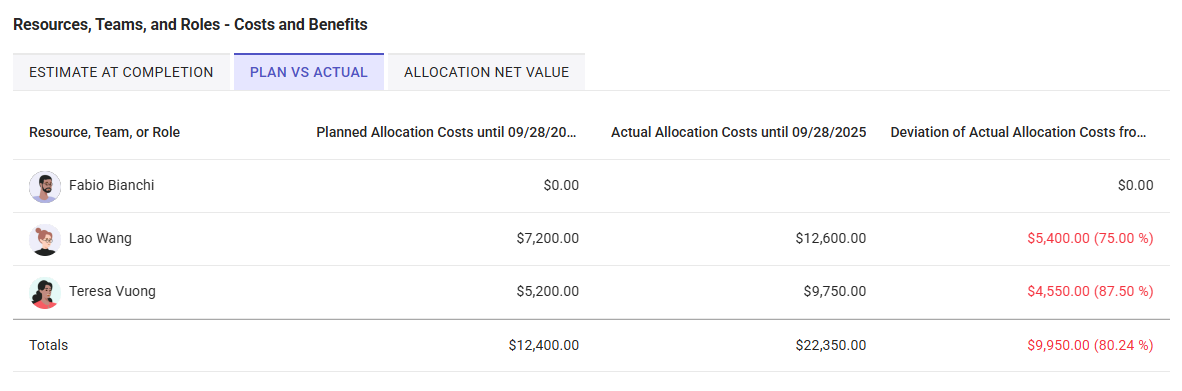

Resources, Teams, and Roles - Costs and BenefitsProPremium
In this section, you can see the Costs per resources, teams, and roles for the respective project. You can compare the planned allocation costs per resource, team, or role with the actual allocation costs. There are three tabs, Estimate at Completion, Plan vs Actual and Allocation Net Value.

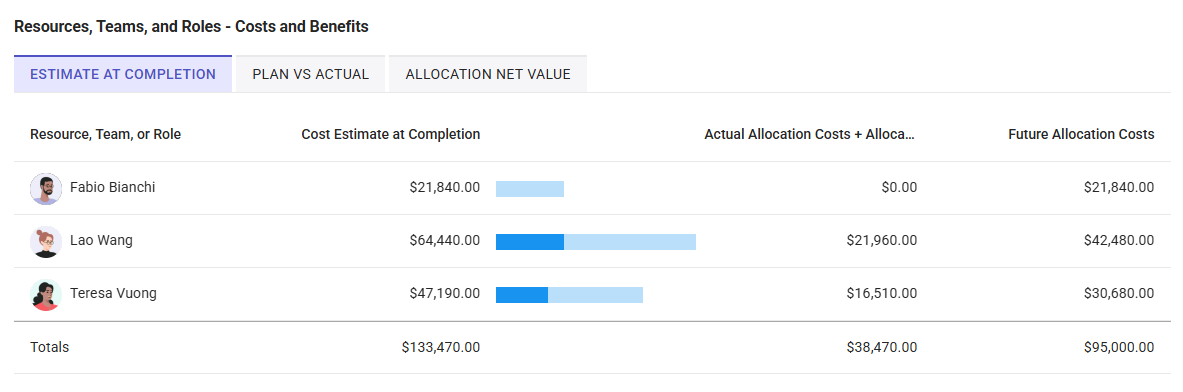

Estimate at Completion:
- Resource, Team, or Role: Name of the resource, team, or role allocated to that project

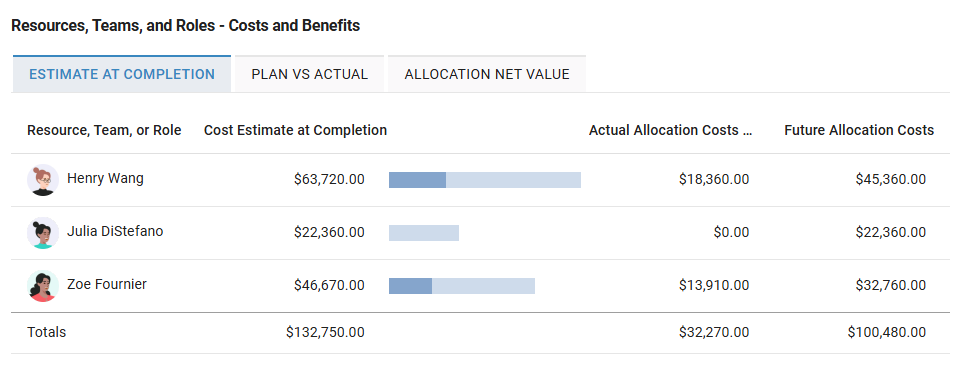

- Estimate at Completion: Sum of actual allocation costs + allocation costs and the remaining allocation costs from today on
- Future Allocation Costs: Allocation costs for this resource, team, or role from today on
Plan vs Actual:
- Resource, Team, or Role: Name of the resource, team, or role allocated to that project

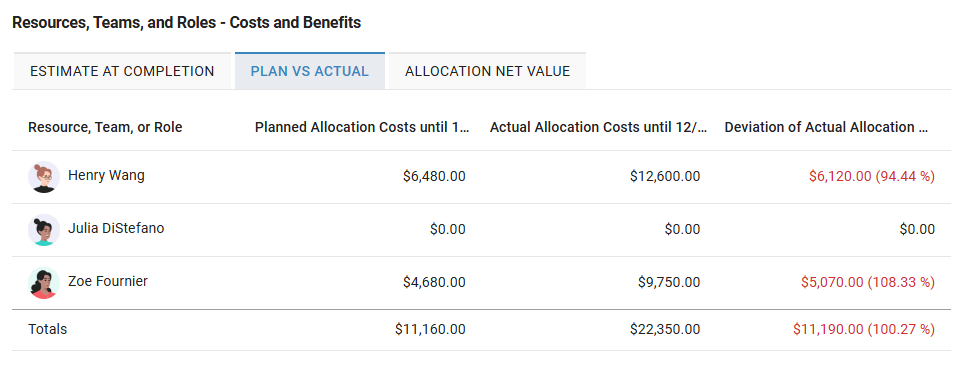

- Planned Allocation Costs until 'Last Booking Date': Sum of planned allocation costs for the resource, team, or role until and including the date mentioned
- Actual Allocation Costs until 'Last Booking Date': Sum of actual allocation costs for the resource, team, or role until and including the date mentioned
- Deviation of Actual Allocation Costs from Planned: The difference between actual allocation costs and planned allocation costs for the resource, team, or role displayed in time unit or percent, with a positive number indicating that the actual allocation costs are higher than the planned allocation costs
Allocation Net Value:
- Resource, Team, or Role: Name of the resource, team, or role allocated to that project
- Allocation Benefit EAC: Allocation EAC x Billing Rate
- Allocation Cost EAC: Allocation EAC x Cost per Hour
- Allocation Net Value EAC: Allocation Benefit EAC - Allocation Cost EAC

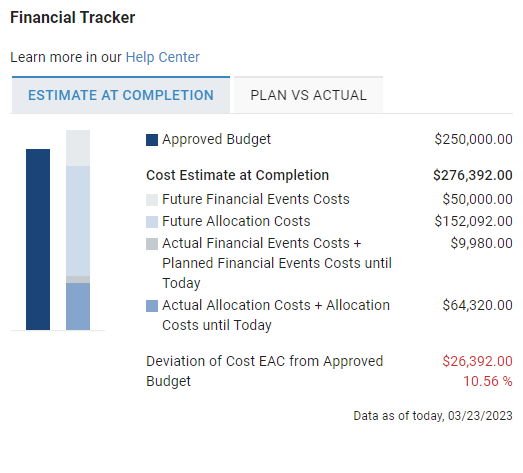

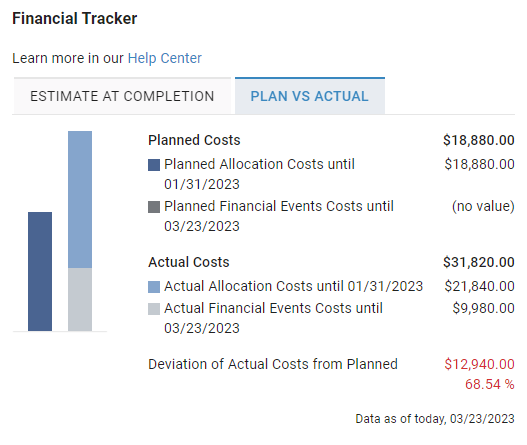

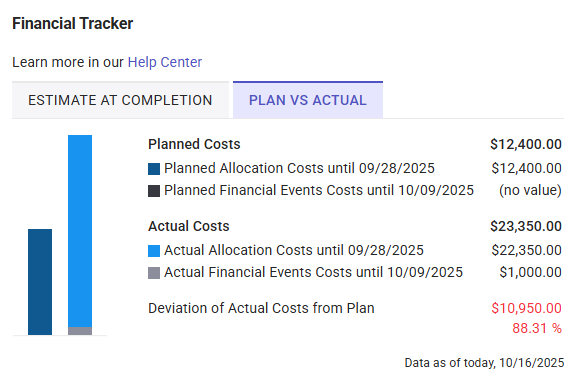

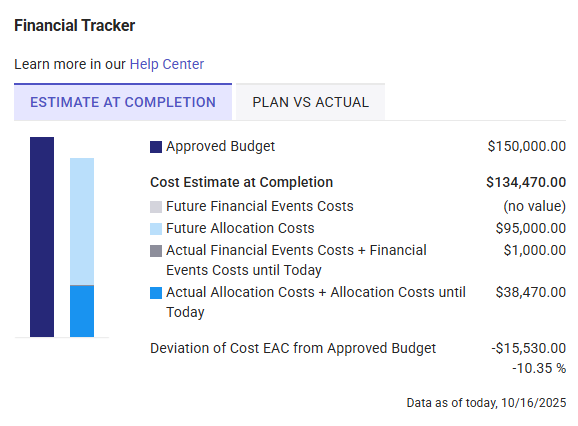

Financial TrackerPro Premium
In this section, you can compare the sum of planned and actual costs until the last booking date. There are two tabs, Estimate at Completion and Plan vs Actual
Estimate at Completion:
- Approved Budget: The project budget entered in the Approved Budget field
-
Cost Estimate at Completion:
- If actual time worked has been imported for this project, then it is the sum of future financial events costs, future allocation costs, past financial events costs and actual allocation costs + allocation costs until today
- If no actual time worked has been imported for this project, then it is the sum of allocation costs and financial events costs
- Future Financial Events Costs: Financial events costs planned for the future
- Future Allocation Costs: Allocation costs planned for the future
- Actual Financial Events Costs +Financial Events Costs until Today: Sum of financial events costs actually incurred, calculated from the imported financial events worked plus planned financial events costs from the last booking date until today
- Actual Allocation Costs + Allocation Costs until Today: Sum of allocation costs actually incurred, calculated from the imported actual time worked plus planned allocation costs from the last booking date until today
- Deviation of Cost EAC from Approved Budget: The difference between the Cost Estimate at Completion and the approved budget displayed in time unit or percent, with a positive number indicating that the cost EAC is higher than the approved budget
- Deviation of Planned Costs from Approved Budget: The difference between the planned costs and the approved budget displayed in time unit or percent, with a positive number indicating that the planned costs are higher than the approved budget
Plan vs Actual:
- Planned Allocation Costs until 'Last Booking Date': Sum of planned allocation costs until and including the date mentioned
- Planned Financial Events Costs until 'Last Booking Date': Sum of planned financial events costs until and including the date mentioned
- Actual Allocation Costs until 'Last Booking Date': Sum of actual allocation costs until and including the date mentioned
- Actual Financial Events Costs until 'Last Booking Date': Sum of actual financial events costs until and including the date mentioned
- Deviation of Actual Costs from Planned: The difference between actual and planned costs displayed in currency and percent, with a positive number indicating that the actual costs are higher than the planned costs

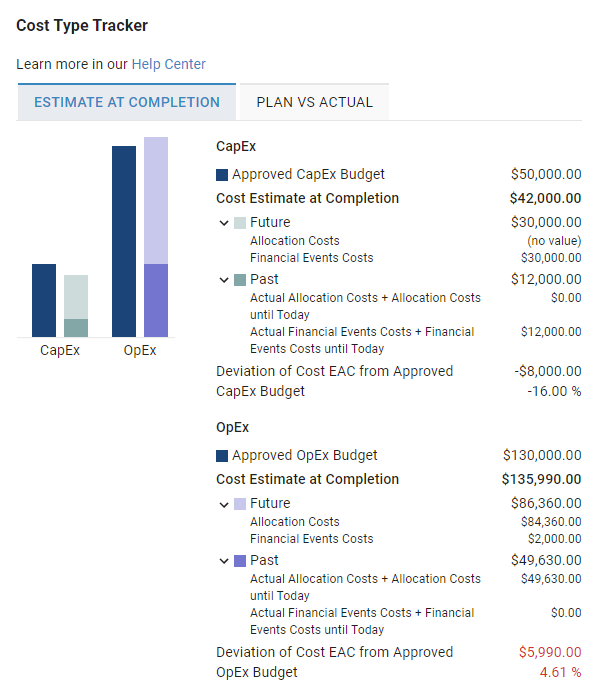

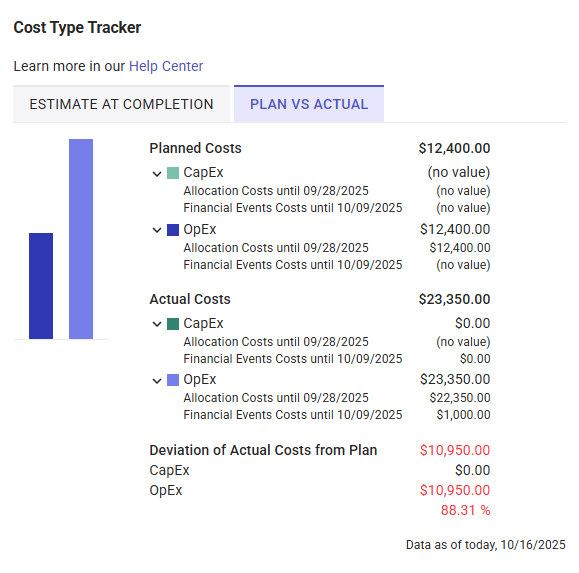

Cost Type TrackerPro Premium
In this section, you can compare the sum of planned and actual costs until the last booking date with the approved CapEx and OpEx budgets. The costs are divided by CapEx and OpEx and consist of allocation costs and financial events costs. There are two tabs, Estimate at Completion and Plan vs Actual.
Estimate at Completion:
- Approved CapEx Budget: The project budget entered in the Approved CapEx Budget field
- Approved OpEx Budget: The project budget entered in the Approved OpEx Budget field

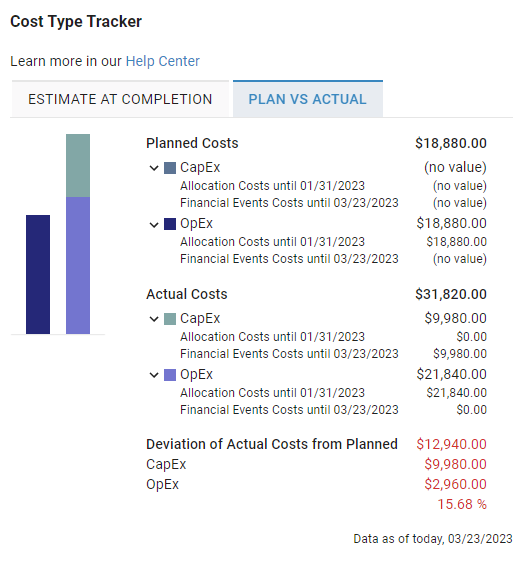

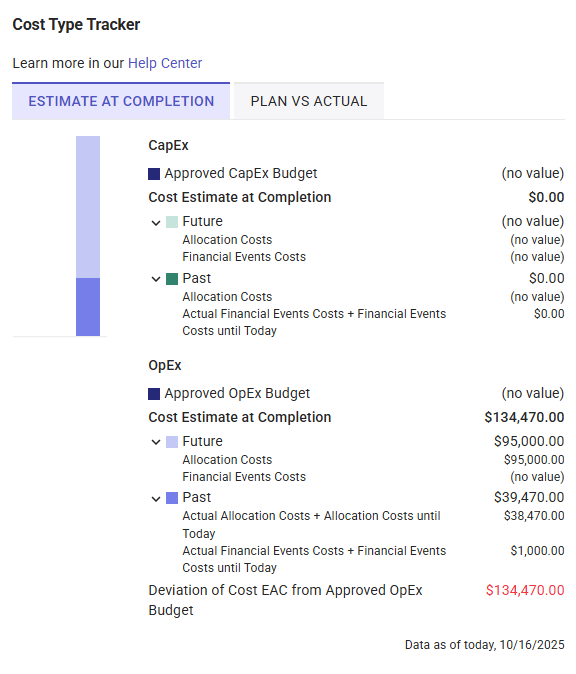

- Cost Estimate at Completion: Sum of future costs and and actual costs + costs until today, for CapEx and OpEx each
- Deviation of Cost EAC from Planned Costs: The difference between the planned costs and the approved CapEx or OpEx budget displayed in time unit or percent, with a positive number indicating that the planned costs are higher than the approved budget
- Deviation of Cost EAC from Approved (CapEx or OpEx) Budget: The difference between the Cost Estimate at Completion and the approved CapEx or OpEx budget displayed in time unit or percent, with a positive number indicating that the cost EAC is higher than the approved budget
- Deviation of Planned Costs from Approved (CapEx or OpEx) Budget: The difference between the planned costs and the approved CapEx or OpEx budget displayed in time unit or percent, with a positive number indicating that the planned costs are higher than the approved budget
- Future: Sum of allocation costs and financial events costs planned as CapEx
- Past: Sum of actual allocation costs + allocation cost until today and financial events costs planned as CapEx
- Actual Allocation Costs + Allocations Costs until Today: Sum of actual allocation costs calculated by import of Actuals - Time Worked and the planned allocation costs between the last booking date and today
- Actual Financial Events Costs + Financial Events Costs until Today: Sum of actual financial events costs calculated by import of actual financial events and the planned financial events costs between the last booking date and today
- Total Planned Costs: Sum of planned allocation costs and planned financial events costs
Plan vs Actual:
-
Planned Costs: Sum of costs planned as CapEx and OpEx
-
CapEx: Sum of allocation costs and financial events costs planned as CapEx
- Allocation Costs until 'Last Booking Date': Allocation costs planned as CapEx until and including the date mentioned
- Financial Events Costs until 'Last Booking Date': Financial events costs planned as CapEx until and including the date mentioned
-
OpEx until 'Last Booking Date': Sum of allocation costs and past financial events costs planned as OpEx until and including the date mentioned
- Allocation Costs until 'Last Booking Date': Allocation costs planned as OpEx until and including the date mentioned
- Financial Events Costs until 'Last Booking Date': Financial events costs planned as OpEx until and including the date mentioned
-
CapEx: Sum of allocation costs and financial events costs planned as CapEx
-
Actual Costs: Sum of planned costs and actual allocation costs planned as CapEx and OpEx
-
CapEx until 'Last Booking Date': Sum of actual allocation costs and past financial events costs planned as CapEx until and including the date mentioned
- Allocation Costs until 'Last Booking Date': Actual allocation costs planned as CapEx until and including the date mentioned
- Financial Events Costs until 'Last Booking Date': Actual financial events costs planned as CapEx until and including the date mentioned
-
OpEx until 'Last Booking Date': Sum of actual allocation costs and past financial events costs planned as OpEx until and including the date mentioned
- Allocation Costs until 'Last Booking Date': Actual allocation costs planned as OpEx until and including the date mentioned
- Financial Events Costs until 'Last Booking Date': Actual financial events costs planned as OpEx until and including the date mentioned
-
CapEx until 'Last Booking Date': Sum of actual allocation costs and past financial events costs planned as CapEx until and including the date mentioned
-
Deviation of Actual Costs from Planned: The difference between the sum of planned and actuals costs per CapEx and OpEx, with a positive number indicating that the actual costs are higher than the planned costs
- CapEx: Difference between planned and actual costs as CapEx, with a positive number indicating that the actual costs are higher than the planned costs
- OpEx: Difference between planned and actual costs as OpEx, with a positive number indicating that the actual costs are higher than the planned costs
Find more information on the comparison of the approved budget, planned costs and actual allocations in the Approved Budget and Actual Allocation Costs article.

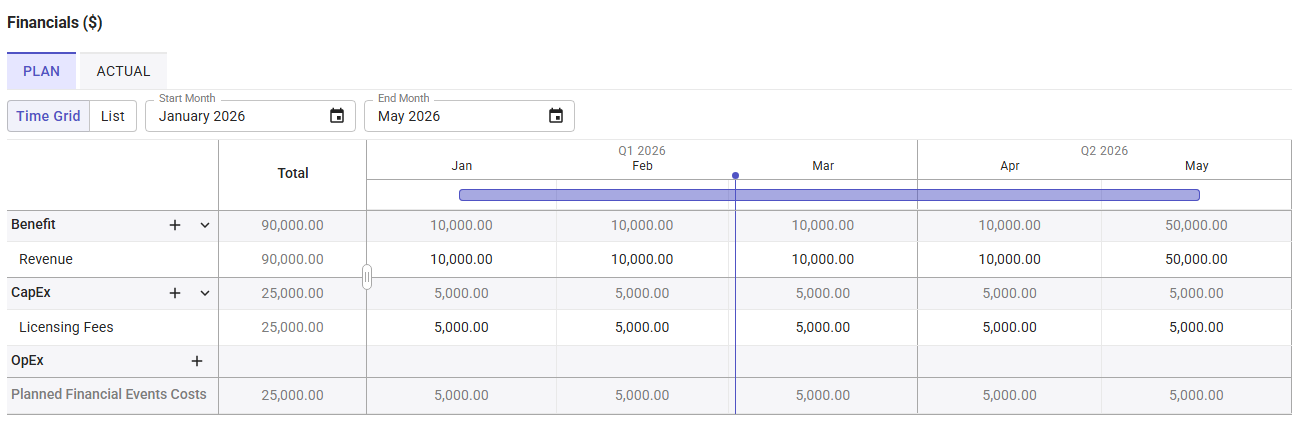

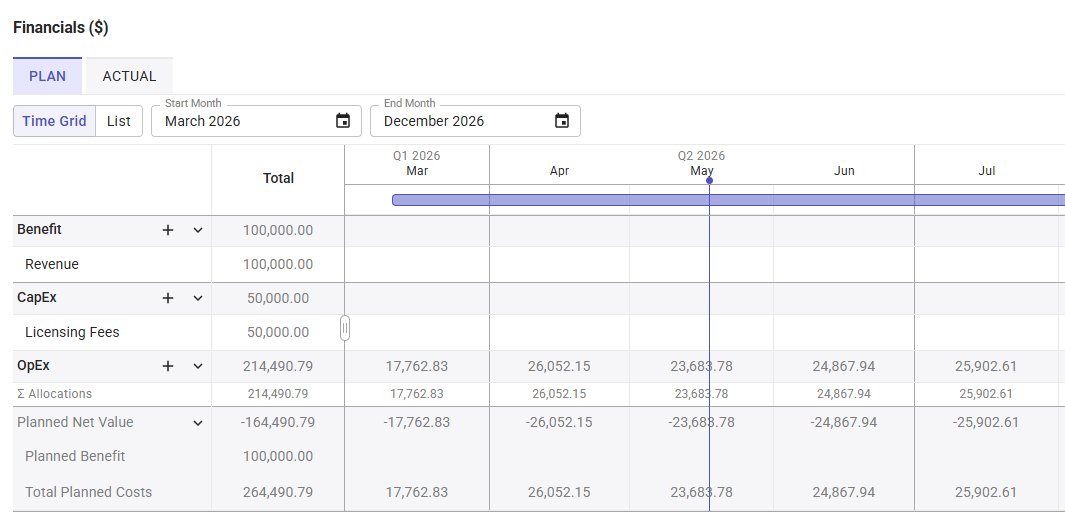

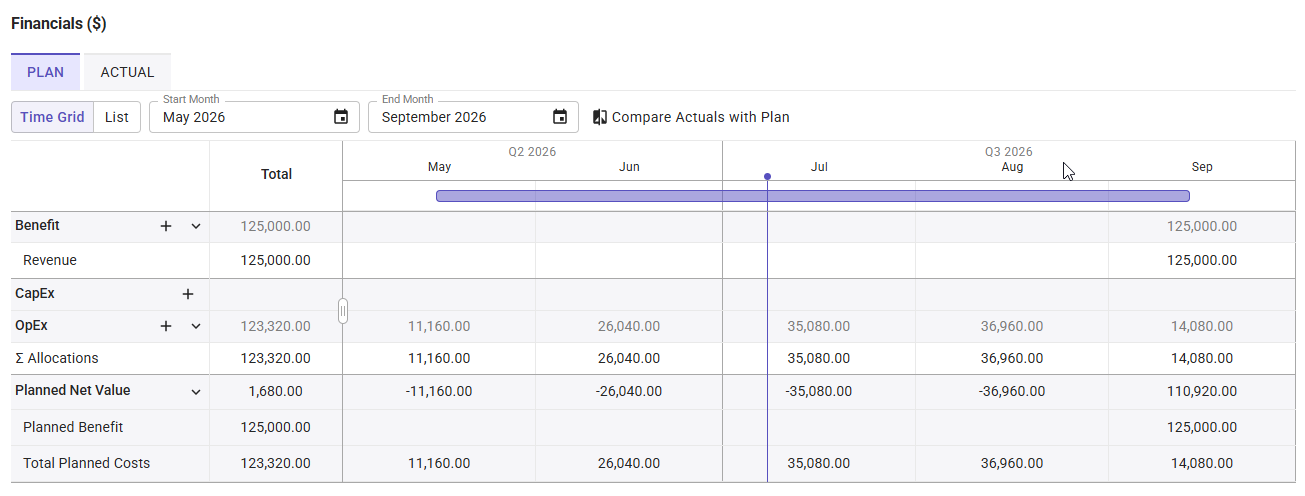

FinancialsPro Premium

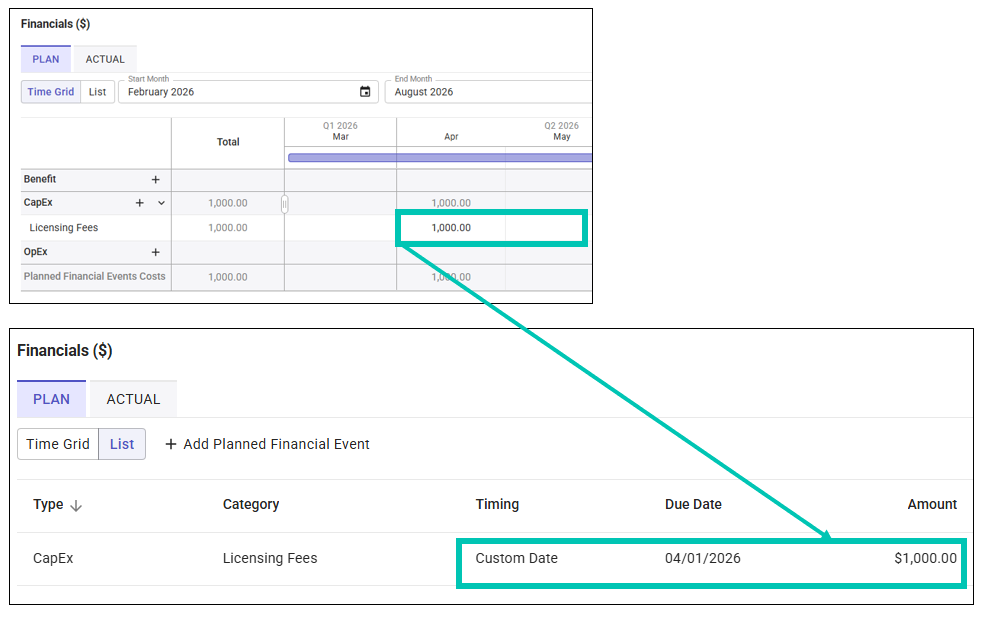

In this section, you can manage the financial events of your project. There are two tabs, Plan and Actual.

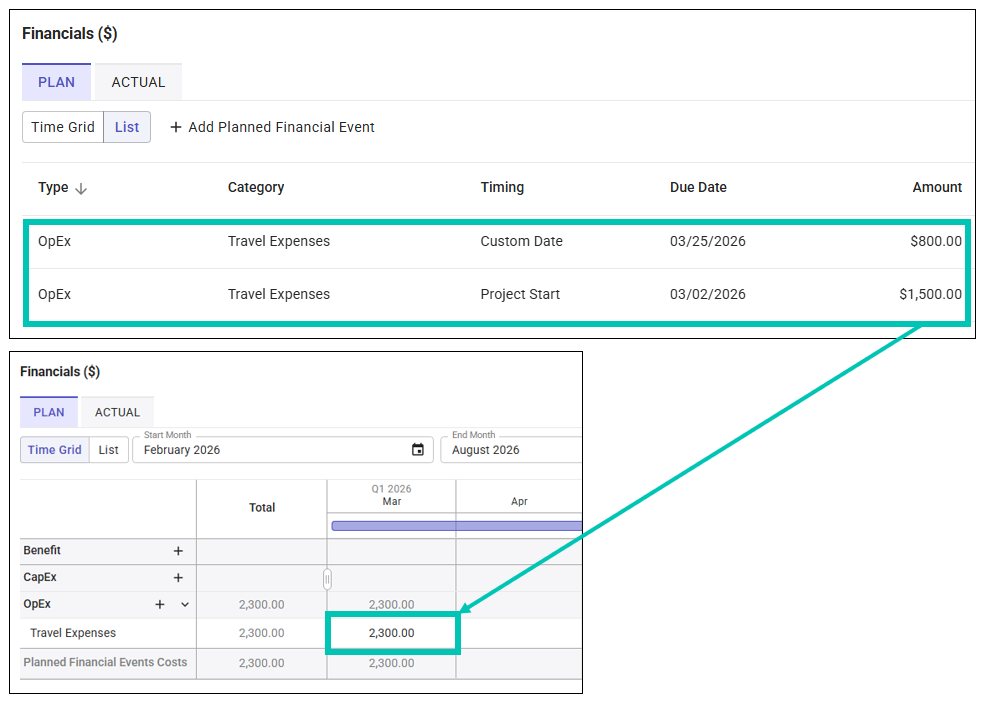

Plan

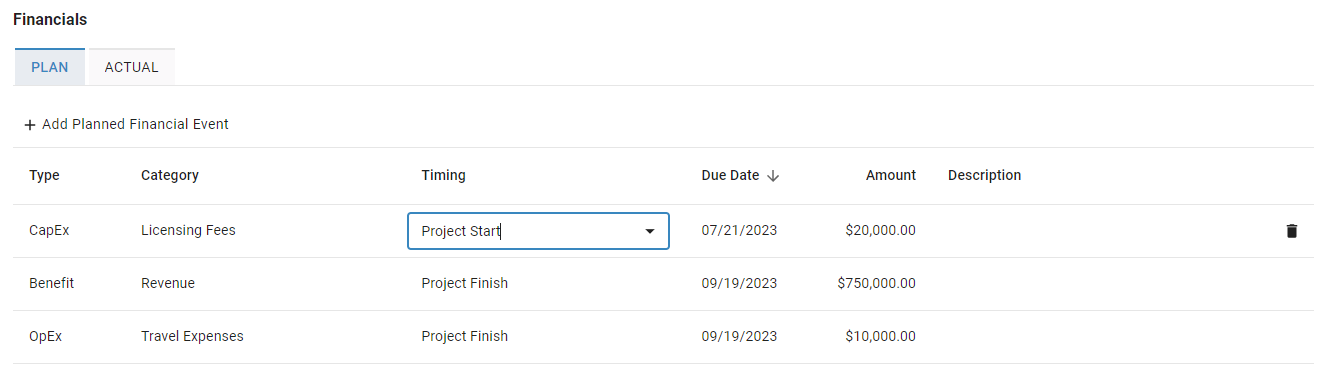

The following information is available for each planned financial event:
- Type: OpEx (Operational Expenditure), CapEx (Capital Expenditure) or Benefit (default)
- Category: Finance categories are managed under Manage > General Settings
- Timing: Define when the event occurs: at the Project Start, the Project Finish (default), any milestone or on a specific date
- Due Date: You can enter a specific date if you have selected Custom Date under Timing. This date can also be set after a project's finish date. If you select a milestone or the project's start or finish date, the date of the selected timing is automatically entered
- Amount: If you do not specify an amount, or delete an existing one, this field will be automatically set to 0.00
- Description
To add a new financial event, click Add Financial Event. To change or delete an event, use the appropriate icon on the far right.
Actual
The following information is available for each actual financial event:
- Type: OpEx (Operational Expenditure), CapEx (Capital Expenditure) or Benefit (default)
- Category: Finance categories are managed under Manage > Advanced
- Booking Date: Due date of the actual financial event
- Amount: If you do not specify an amount, or delete an existing one, this field will be automatically set to 0.00
- Description
To add a new actual financial event, click Add Financial Event. To change or delete an event, use the appropriate icon on the far right.
RisksPro Premium
In this section, you can add, edit, and delete project risks.
In addition to custom fields, you can display the following system fields:
- Name: Required field; name of the risk in the current project
- Risk Key: Unique identifier automatically assigned by the system; you can adjust it at any time
- Risk Owner: Assign a resource as the contact person for each risk. This person monitors the risk and communicates any changes

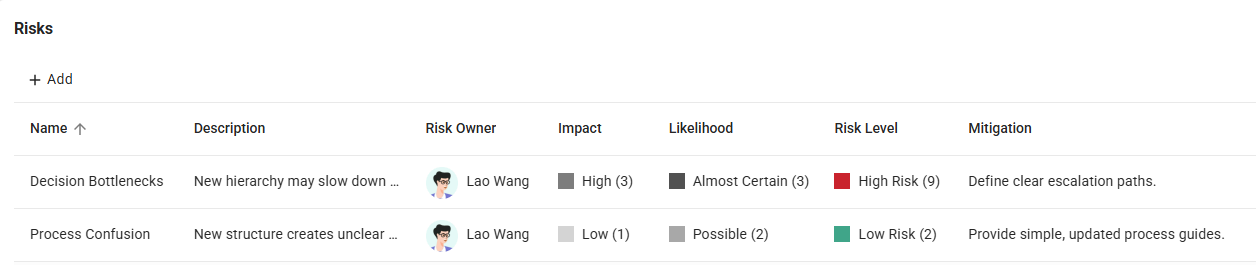

- Impact: Under Manage > Custom Fields > Risk Fields > Impact, define the Priority Score Contribution for the degree of impact, and adjust the value for each risk in the project details view
- Likelihood: Under Manage > Custom Fields > Risk Fields > Likelihood, define the Priority Score Contribution for the degree of likelihood, and adjust the value for each risk in the project details view
- Risk Level: Under Manage > Custom Fields > Risk Fields > Risk Level, define the ranges; the risk level is calculated by multiplying the impact by the likelihood
Click Add Risk to create a new risk. To delete a risk, hover over the risk you want to remove and then click the trash icon at the end of the row. To edit the details of a risk, simply click the respective field.
To create custom fields for your risk management, go to Manage > Custom Fields > Risk Fields and click Add Risk Field in the toolbar.
You can find all details in the article Project Risks.
