Availability All Editions
To improve the flexibility and usability when working with milestones, and to better support managing allocations by phases, we are redesigning how milestones, phases, and allocations interact in Meisterplan.
- Summary
- Current Behavior
- Future Behavior
- Migration Details
- Recommended Actions Before Release
- Recommended Actions After Release
- Feedback & Questions
Summary
- We will separate points in time (milestones) from time spans (phases).
- We will introduce project segments, allowing you to:
- Divide projects into time-based sections (segments),
- Edit project allocations per segment.
- Assign phases to segments.
Current Behavior

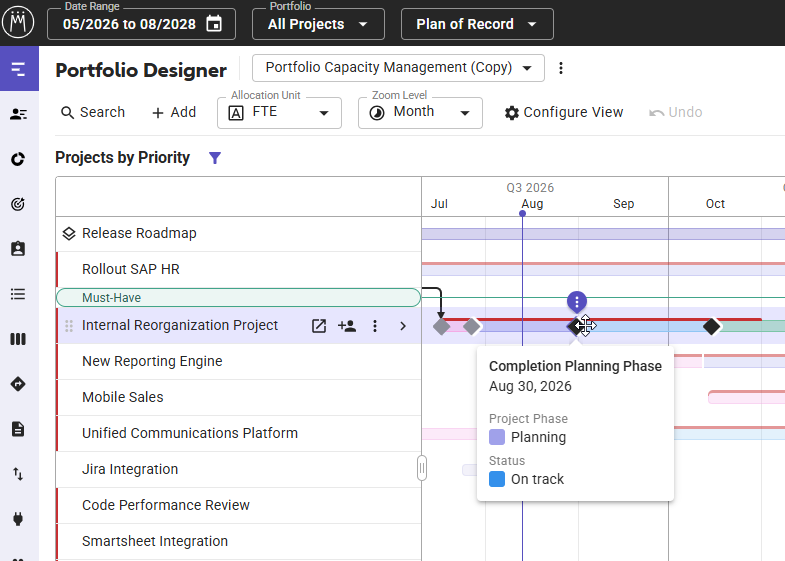

Phases and Milestones
- Phases are dependent on milestones.
- To define a phase, you need a milestone to mark the end of said phase.
- The phase start is defined either by the previous phase, or the project start date.
- When you move a milestone, the corresponding phase is moved (stretched or shrunk).
Allocations
- Allocations are not dependent on milestones or phases.
- In the classic Portfolio Designer, you can create flexible segments that correspond to the phases, but they do not update when milestones (and thus phases) change.
- However, in the beta Allocations by Project Phases, allocations are linked to phases via milestones.
Independent Milestones
Milestones do not have to be assigned to a phase. You can create standalone milestones that are independent of phases and allocations.
Future Behavior
With this change, you can manage milestones, phases, and allocations independently: milestones mark key points in time, segments divide projects and allocations into time-based sections, and phases organize project work into meaningful stages. This gives you greater flexibility in project planning and makes it easier to adjust allocations throughout the project lifecycle.

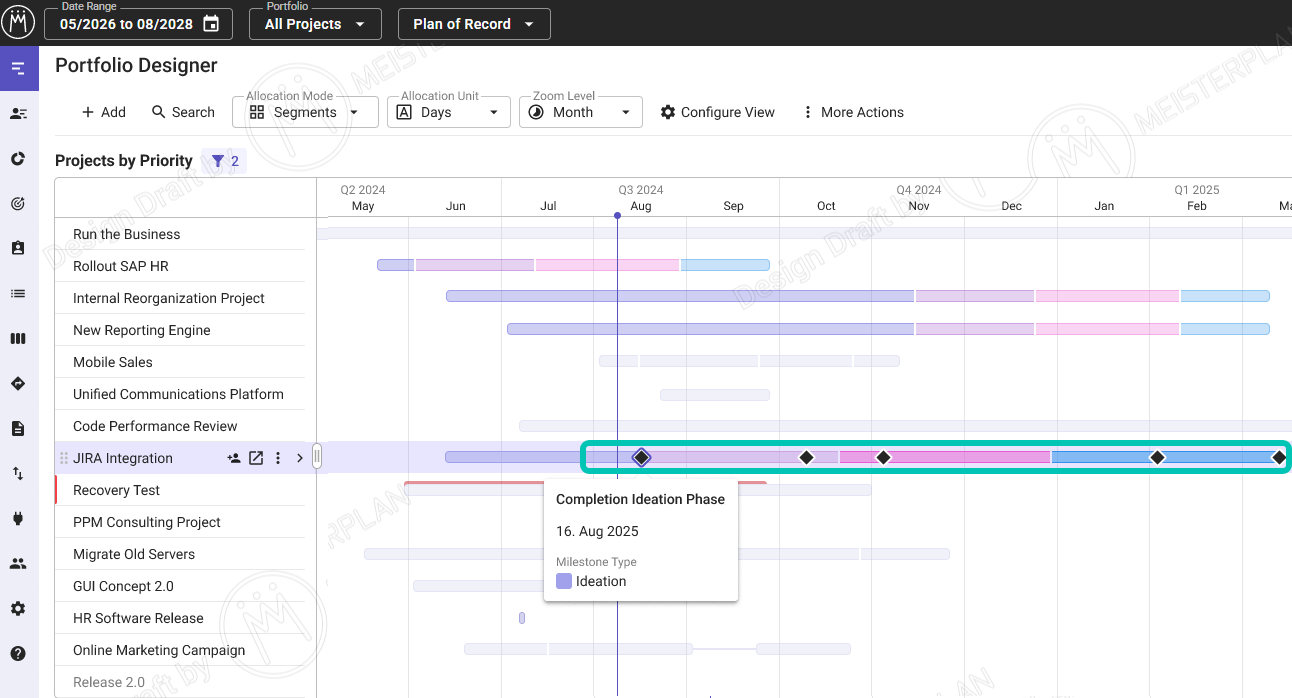

Milestones
- Milestones will no longer be dependent on phases. They can be moved independently without affecting phases, segments, or allocations.
- If you move a milestone, it will no longer affect the color-coding of the project bar.
- The milestone field Project Phase will be replaced by the new Milestone Type field. You can use this field to:
- Categorize milestones (e.g., delivery, quality gate, financial)
- Filter milestones
- Analyze milestones in reports
- A new read-only field In Project Phase will show the phase in which a milestone lies, but it does not tie the milestone to the phase.
Segments and Allocations

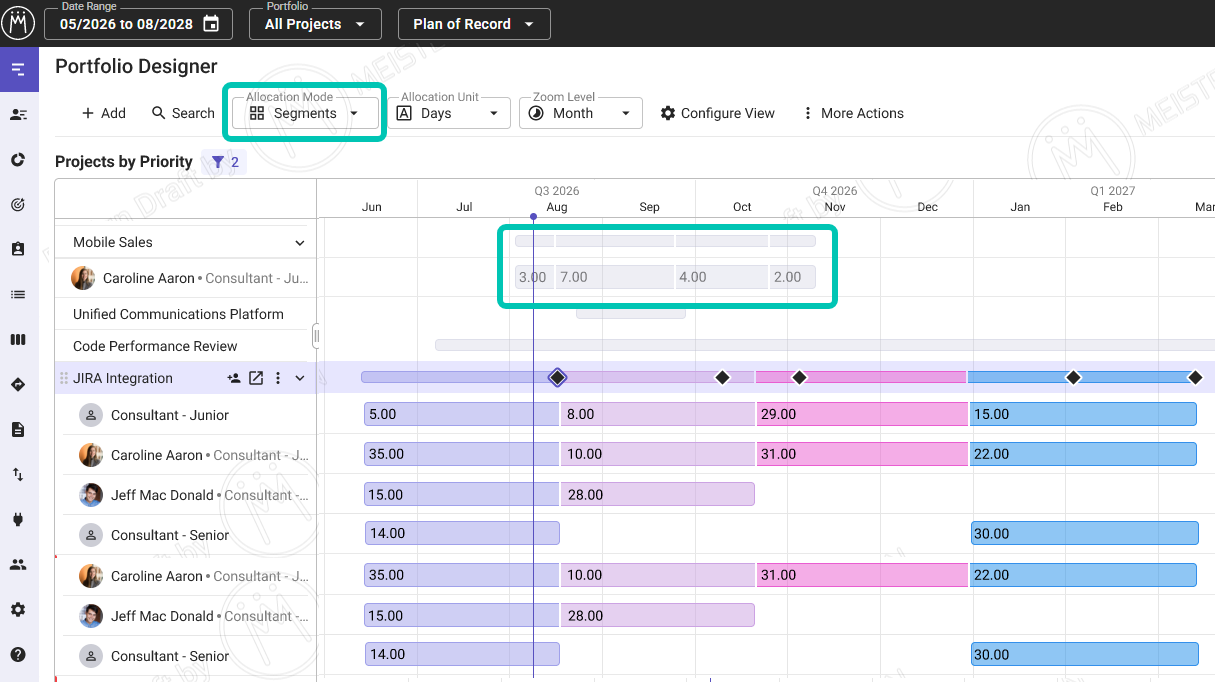

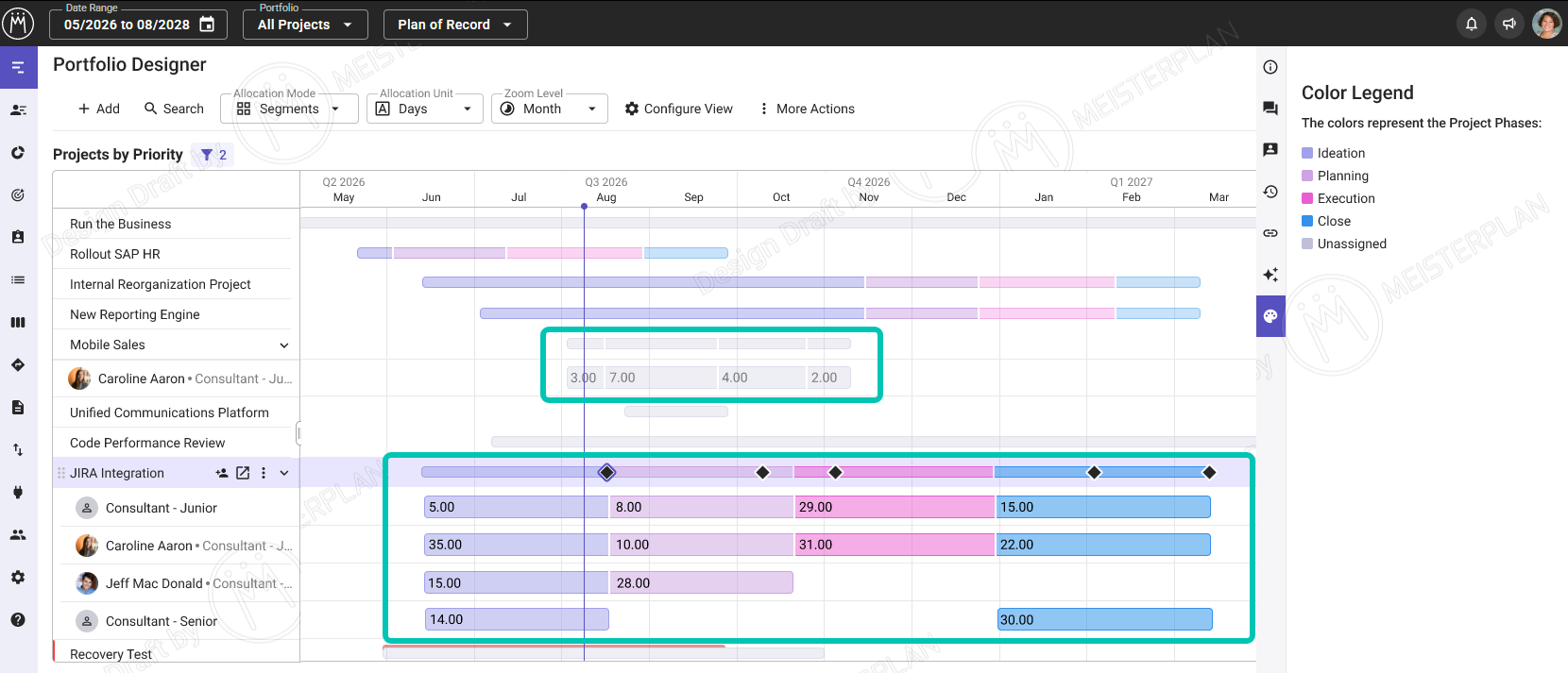

- In the new Portfolio Designer, the Team Planner, and the Staffing Mode, a new allocation mode Segments will be available, and in this mode:
- You will be able to define segments by configuring a finish date. The start date is derived from the previous segment or the project start.
- All allocations will be split according to the segments. You can assign, move, extend, or shrink allocations per segment.
- You will be able to assign phases to segments to keep phases and allocations aligned. However, this is optional, and you can use segments without phases.
Migration Details
- Planned release: December
- Existing phases will become segments with phases assigned.
- Segment finish dates will match the milestone date that previously concluded the phase.
- The Project Phase field will be renamed Milestone Type and can be edited under Manage > Custom Fields > Milestones. The phases will be available as single-select options of this field.
- The Project Phase field in each milestone will become the Milestone Type field and retain the name of the phase.
- REST and Reporting API calls will continue to work.
- The Allocations by Project Phases beta in the Project Details will be discontinued.
- The beta allocation mode Phases will be replaced with the new Segments allocation mode.
- At a later date, the new phase and segment behavior will be applied to the Allocations tab in the Project Details.
Recommended Actions Before Release
- Review your milestones and phases and update them to prepare for the segment migration.
- If you do not want to work with segments nor the new Milestone Type field, remove the phases from your milestones.
- Inform your Meisterplan users so they can adapt their workflows and separate points in time from time spans.
Recommended Actions After Release

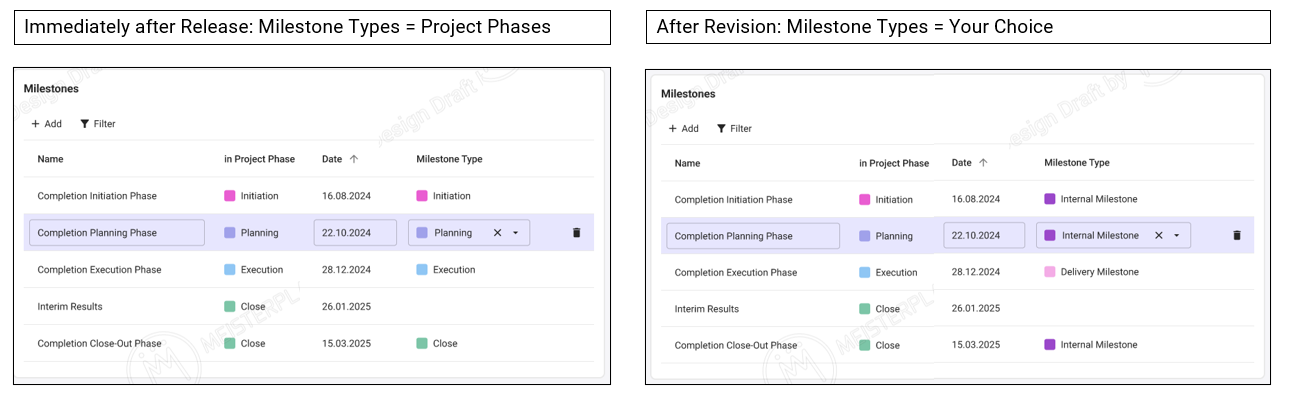

- Review the Milestone Type field options under Manage > Custom Fields > Milestones. Right after release, the options in the Milestone Type field correspond to the project phases. We recommend creating the milestone types you actually need instead:
Feedback & Questions
If you have questions or feedback on this upcoming change, please contact us at support@meisterplan.com.
