Availability All Editions
You can add, edit and delete allocations in both the Time Grid and Compact mode of the Team Planner. For more information on these modes, click here.
Required User Rights
To edit allocations in the Team Planner, you need to be in a user group with the following rights:
- You need to have edit rights for the currently selected scenario or the Edit Plan of Record right.
- Either the right Resource Managers Can Always Edit Allocations of Their Own Resources, Teams, and Roles, or under Edit Allocations, at least the option Role Allocations.
You can only replace resources, teams, and roles that have an allocation value greater than 0 in at least one period of time.
Editing Allocations
The Team Planner offers many options to quickly edit existing allocations. Besides manually editing allocation values, there are also special functions to edit allocations. For more information on this, see the article on mouse and keyboard shortcuts.
If a padlock icon is displayed when you select a project, this indicates the project is not part of the current portfolio and its allocation segments cannot be edited.
Editing Part of an Allocation (Time Grid Mode)
To edit single allocation values in cells, click the cell and enter the new value. With our keyboard shortcuts, you can select and edit multiple cells at once, like with copying or overwriting cells.
Additionally, you can open the context menu, which offers you further editing-functionality. Select one or more cells and click the three dots in the blue bubble above the selected cells. There you will find the following options:

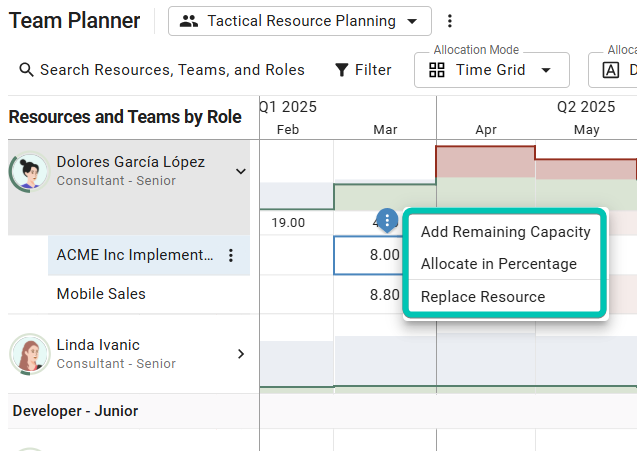

- Add Remaining Capacity: The remaining available capacity of the resource, team or role will be added to the selected cells.
- Allocate in Percentage: The selected allocation cells will be filled with the specified percentage of the resource's, team's or role capacity. Existing values will be overwritten.
-
Replace Resource/Team (for resources and teams): All of the selected values will be allocated to the desired resource or team, and the existing allocation will be deleted from the current resource or team. You can replace the entire allocation, only the overallocation or a percentage of the allocation.
- Unstaff to Role: Once you select Replace Resource/Team, you will be able to unstaff the entire allocation back to the role, only the overallocation or a percentage of the allocation. All of the selected values will be allocated to the role, and the existing allocation will be deleted from the current resource or team. Learn more in the article Team Planner - Replacing Resource Allocations.
Editing an Allocation Segment (Compact Mode)
When you select a project beneath a resource, team or role in Compact Mode, and click on the three dots next to the project name, you will find the following options to edit the entire allocation segment:
- Staff Role (only for roles): Open a new view where you can staff available resources and teams to role-level allocations. Learn more in the article Staff Role.
- Replace Role (only for roles): All of the selected values will be allocated to the desired role, and the existing allocation will be deleted from the current role.
-
Replace Resource/Team (for resources and teams): All of the selected values will be allocated to the desired resource or team, and the existing allocation will be deleted from the current resource or team. You can replace the entire allocation or a percentage of the allocation.
- Unstaff to Role: Once you select Replace Resource/Team, you will be able to unstaff the entire allocation back to the role, only the overallocation or a percentage of the allocation. All of the selected values will be allocated to the role, and the existing allocation will be deleted from the current resource or team. Learn more in the article Team Planner - Replacing Resource Allocations.

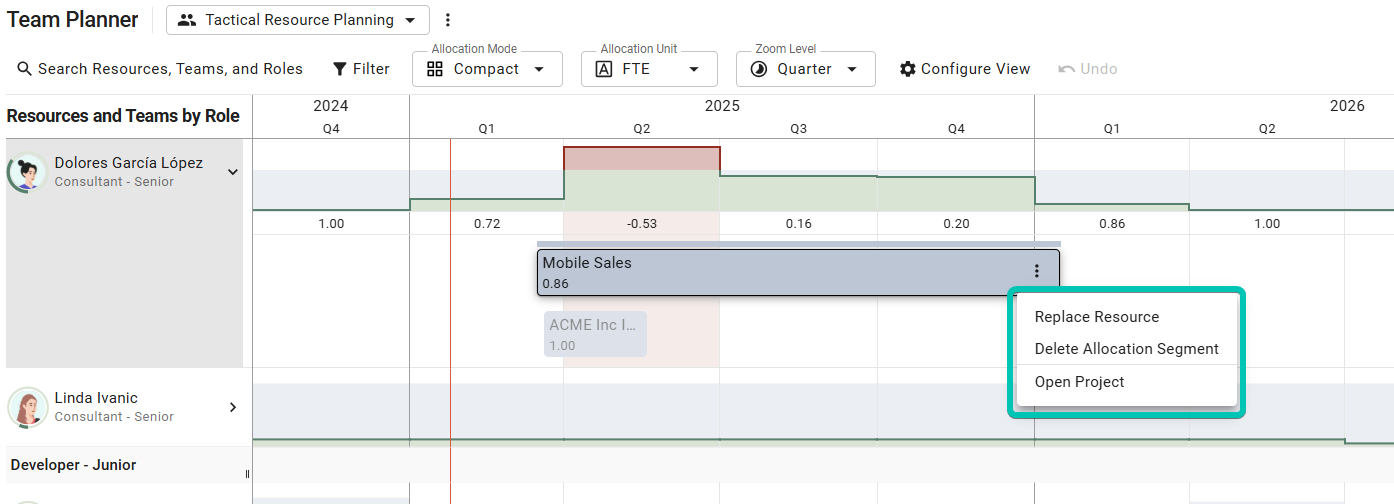

- Delete Allocation Segment: Set the allocation value to 0; doing this means that the allocation segment will not be shown in Compact Mode. In other views, the allocation remains visible.
- Open Project: Open the project's details.
Editing an Entire Allocation (Time Grid Mode)

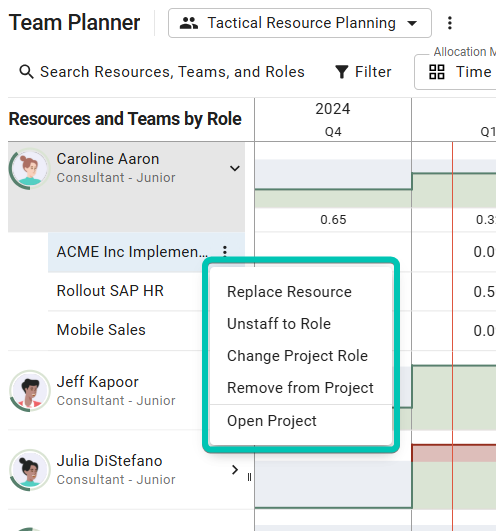

In Time Grid Mode, you can edit the entire allocation or a resource, team or role. Click the three dots next to the name of the project to open the context menu. There you will find the following actions:
- Staff Role (only for roles): Open a new view where you can staff available resourcesand teams to role-level allocations. Learn more in the article Staff Role.
- Replace Role (only for roles): All of the selected values will be allocated to the desired role, and the existing allocation will be deleted from the current role.
-
Replace Resource/Team (for resources and teams): All values will be allocated to the desired resource or team, and the existing allocation will be deleted from the current resource or team. Learn more in the article Team Planner - Replacing Resource Allocations. You can replace the entire allocation, only the overallocation or a percentage of the allocation.
- Unstaff to Role: Once you select Replace Resource/Team, you will be able to unstaff the allocation back to the role. All of the selected values will be allocated to the role, and the existing allocation will be deleted from the current resource or team. Learn more in the article Team Planner - Replacing Resource Allocations.
- Change Project Role (only for resources): The resource or team will remain allocated to the project, but in the selected role.
- Unstaff to Role (for resources and teams): The entire allocation will be transferred back to the role, and the existing allocation will be deleted from the current resource or team. Learn more in the article Team Planner - Replacing Resource Allocations.
- Remove from Project: The resource, team or role will be unassigned from this project.
- Open Project: Open the project's details.
Adding Allocations
Time Grid Mode

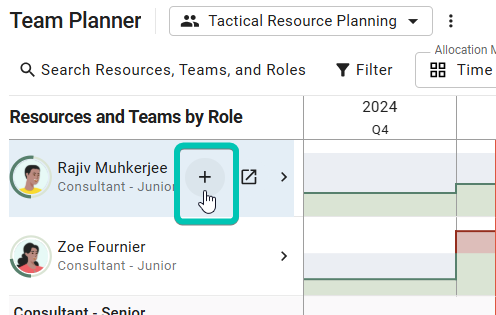

To add a new project allocation for a resource, team or role, move your cursor over the resource, team or role and click the plus icon:

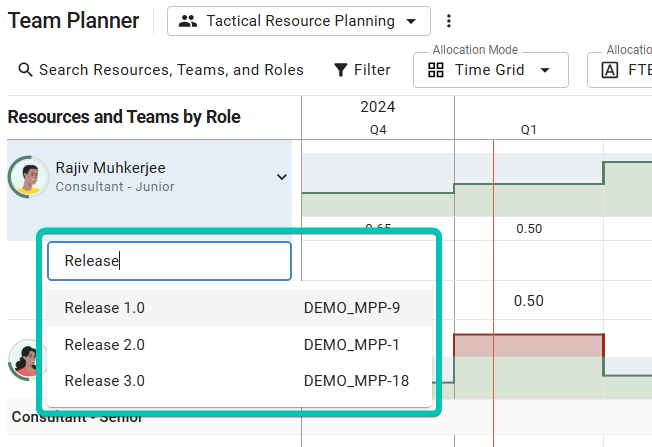

Next, enter the project's name or project key into the search field and confirm with ENTER:
A new row below the resource, team or role will be added with the project's name.
Now, enter the allocation value in the cell or cells and confirm with ENTER. To add the remaining capacity or a resource, team or role in one or more cells, select the desired cells and move your mouse above the selected region. Next, click the three dots to open the context menu. Then, click Add Remaining Capacity.
If you do not enter a value, the project will vanish as soon as you refresh the page, because projects without an allocation value are not displayed.
Compact Mode
To add a new project allocation in the Compact mode, first select the desired time period for the allocation by drawing a rectangle in the timeline while keeping your mouse button pressed. Next, enter the project's name or project key into the search field and press ENTER to confirm. The project allocation will be displayed as a new bar and is already in edit mode. Now, enter the allocation value for the selected time period and press ENTER to confirm.
If you do not enter a value, the segment will vanish as soon as you deselect it or select another segment, because projects without an allocation value are not displayed.
Deleting Allocations
Time Grid Mode
To delete an allocation segment, click the Delete key or enter "0" in the respective cell.
To delete the entire allocation, move your cursor over the project's name, click the three dots at the end of the line and select Remove from Project.
Compact Mode

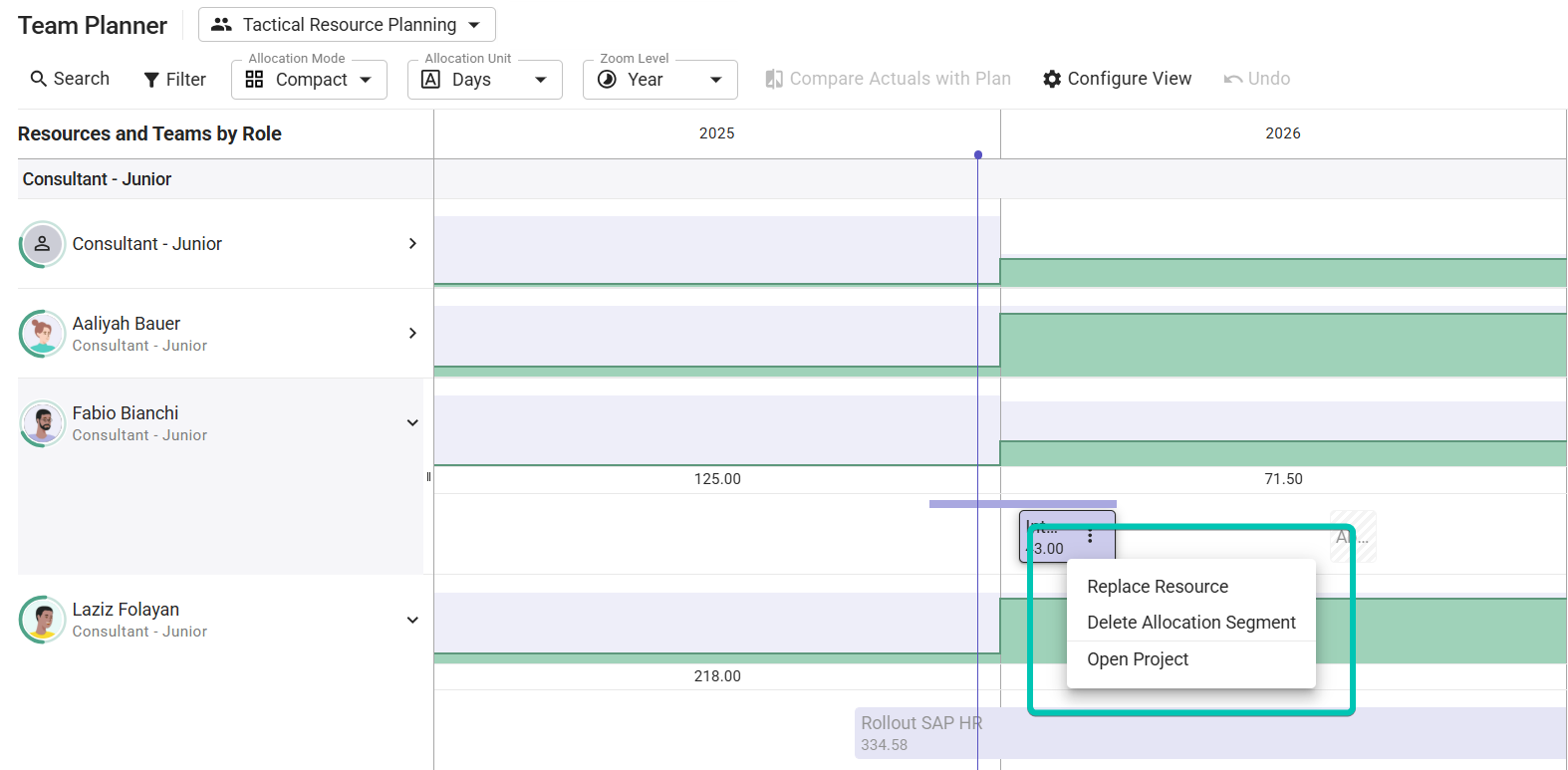

To delete an allocation segment, select the three dots at the end of the allocation segment and select Delete Allocation Segment.
In Compact mode, you can only delete allocation segments.
Undoing Actions
To undo actions in the Team Planner, click the undo button in the toolbar, or select CTRL+Z. You can undo the following actions in the Team Planner's Time Grid mode:
- Allocation changes through inline edit
- copy/cut/paste actions
- deleting allocation values
You can undo the last 99 actions that you have performed, and you can only undo multiple actions up until the last non-undoable action. You cannot undo:
- any action in the Compact mode
- any action in the Staff Role mode
- Unstaff to role
If you leave and return to the Team Planner view, you will not be able to undo any previous actions.
