In this article, you'll learn how to integrate Jira into portfolio planning with Meisterplan.
- 1. Overview: How to Integrate Jira into Portfolio Planning with Meisterplan
- 2. Setting Up the Integration
- 3. Importing Epics directly from within the Meisterplan UI
- 4. Optional: Pushing Projects from Jira
1. Overview: How to Integrate Jira into Portfolio Planning with Meisterplan
Meisterplan provides you with a professional PPM layer focused on capacity and resource planning.
You can easily integrate PM tools, such as Jira, into it.
We recommend the following process:
- Plan new projects in Meisterplan, starting with rough resource demands and dependencies to other projects.
- In Jira, refine the corresponding epics into stories and tasks and synchroonize them with the project plan in Meisterplan.
- Teams remain productive in Jira, while Meisterplan provides an overview of all protfolios.
The integration is flexible and scalable – ideal for organizations that combine agile and traditional working methods.
Alternatively, you can start by creating new initiatives in Jira and transferring them automatically to Meisterplan. You can do this by setting up a Jira automation. We’ll show you how this works in section four.
1.1 Mapping Table: Object Types in Meisterplan and Jira
This table shows the corresponding object types in Meisterplan and Jira, as well as the relevant mappings for consistent integration in project portfolio management.
Both Meisterplan and Jira offer central planning units, effort estimates, and execution structures. These interact as follows and form the basis for integrated steering.

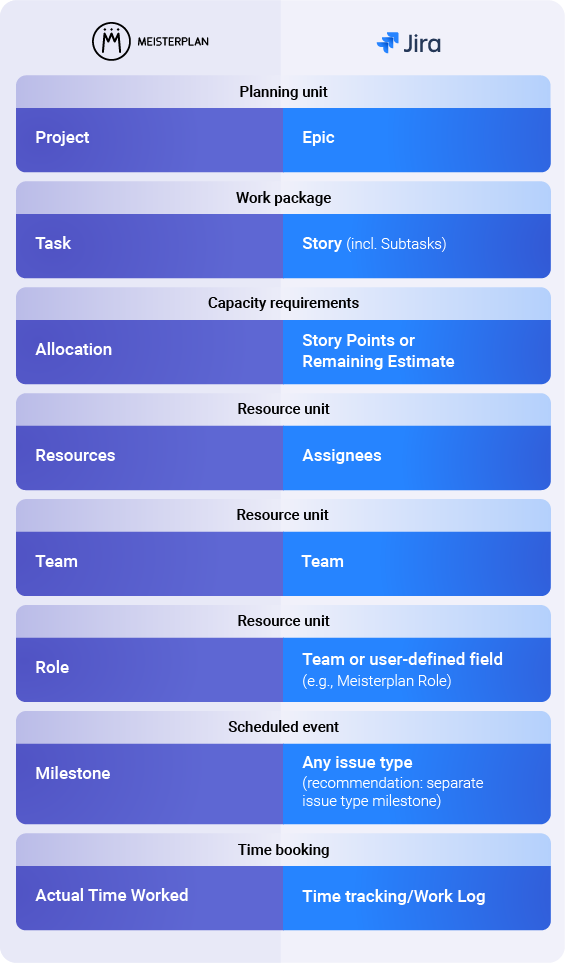

Mapping Table |
Meisterplan |
Jira |
|---|---|---|
Planning Unit: Project ↔ Epic |
In Meisterplan, projects are planned as structured containers for work – with defined start and end dates, estimated effort, and potential dependencies on other projects. |
In Meisterplan, projects are planned as structured containers for work – with defined start and end dates, estimated effort, and potential dependencies on other projects. |
Work Package: Task ↔ Story (Including Subtasks) |
Tasks are not created or planned directly in Meisterplan. Instead, existing tasks from project management tools, such as Jira, are visualized and will stay in sync automatically. Issues created in Jira – usually stories – are under an epic that can then be assigned to a project in Meisterplan and displayed as tasks. These tasks can be displayed in Meisterplan either by date or by sprint. |
Stories are planned with specific effort estimates. Depending on the process, they can either be organized in agile sprints or assigned individual start and end dates. In Meisterplan, these structures can be visualized accordingly and integrated into overall project planning. |
Capacity Requirements: Allocation ↔ Story Points or Remaining Estimate |
Each project in Meisterplan is assigned a total value for the amount of work involved across a specific time period – known as the allocation. This can either be a rough estimate or based on an already approved budget. Planning is done in hours, person-days, or as a percentage of a full-time employee (full-time equivalent, or FTE), depending on the desired granularity. Work effort in story points imported from Jira is converted using custom velocities per team or role. |
Work within an epic is divided into individual stories, estimated, and assigned to specific teams, departments, or individuals. Effort estimates are typically made in the form of story points or time estimates (estimated in hours), which Meisterplan rolls up to the project. |

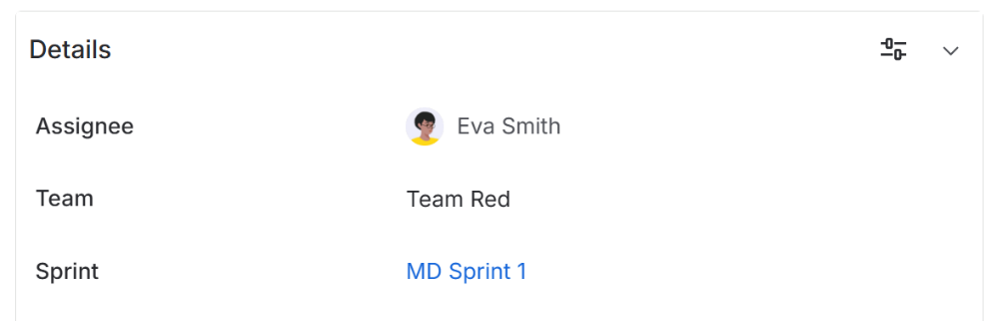

Resource Unit: Resource ↔ Assignee |
In Meisterplan, an individual employee is referred to as a “resource” and can be scheduled on a project. |
In Jira, an assignee is defined as the person who is expected to work on a story. |
|
Resource Unit: Team ↔ Team For organizations with agile working methods, we recommend using the team object in both Meisterplan and Jira. |
Teams in Meisterplan are made up of individual resources. The team capacity is calculated as the sum of the capacities of all assigned individuals. For each resource, you can individually specify what proportion of their capacity is available to the respective team. Please note: A Meisterplan team is not an organizational unit, such as a department. |
In Jira, a team is a group of employees (assignees) who work together on stories. In agile environments, planning is typically done using story points and a jointly defined velocity, which serves as the basis for capacity control. |
|
Resource Unit: Role ↔ Team/Role (Custom Field) For organizations with a conventional project structure, rough planning in Meisterplan on the role level is recommended. In Jira, this can be mapped either via roles or teams.. |
The capacity of a role is calculated from the sum of all capacities of the assigned resources and teams, as well as from additionally defined role capacities. During the planning process, these role assignments are gradually assigned to specific individuals. |
Jira does not have a role object. If you still want to assign work to a role, you can either use the team object or create a custom field within Jira. During the planning process, stories are created and assigned to specific employees for work. |
Scheduled Event: Milestone ↔ Milestones (Custom Type) |
Meisterplan enables the display of milestones within individual projects. Additionally, cross-project dependencies between milestones can be visualized to make strategic dependencies transparent and plan resources in advance. |

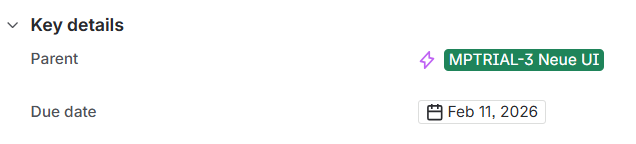

In Jira, a custom issue type “Milestone” is often used to display key project milestones. The due date marks the planned date. |
Time Booking: Actual Time Worked ↔ Time Tracking/Work Log |
Actual time worked is recorded as time entries and compared with historical allocations – an important basis for analyzing plan deviations and optimizing resource utilization. Please note: Users who track their time in Jira must be defined as resources in Meisterplan. |

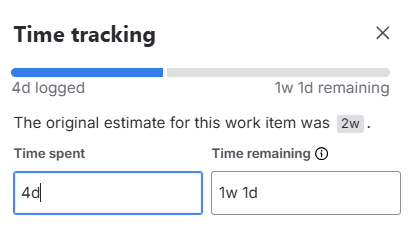

In Jira, time tracking is done either directly on the story or on subtasks that arise during implementation. These actual times can be seamlessly transferred to Meisterplan to compare resource planning with actual effort. |
2. Setting Up the Integration
2.1 Preliminary Work
- Check wether all the object types you plan on using are available and configured in both Meisterplan and Jira.
- Create entities to be planned (team/role/resource) in Meisterplan.
- Ensure corresponding entities in Jira (team/role/resource).

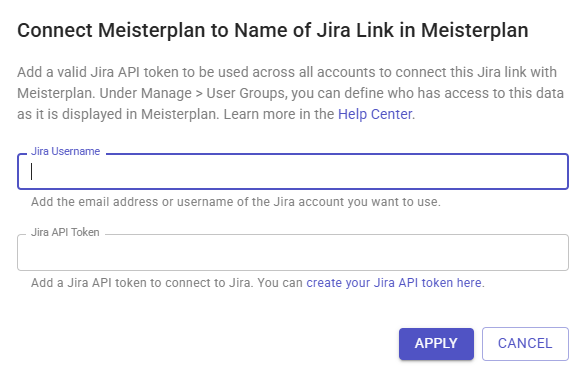

2.2 Connecting the Systems
|
|
|

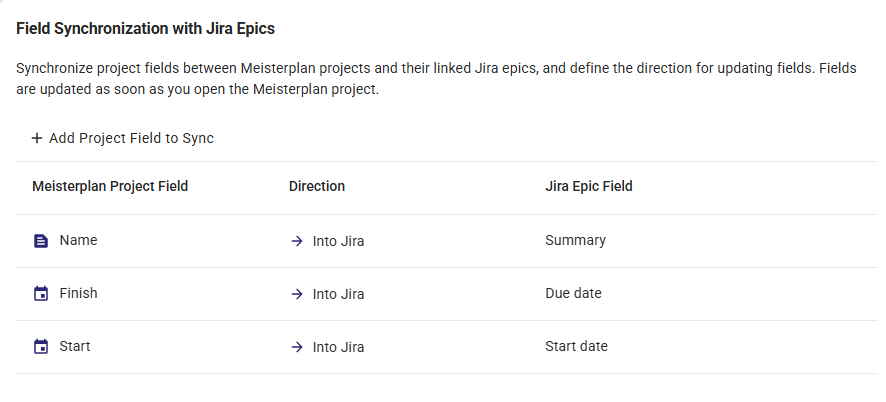

2.3 Defining the Settings

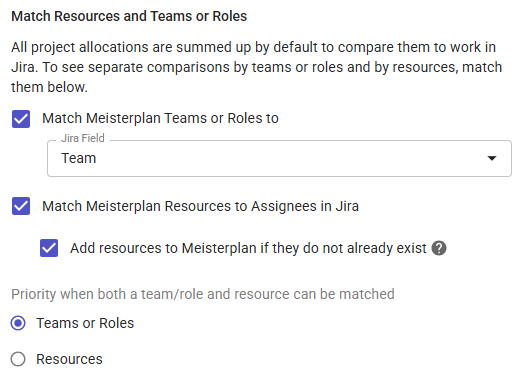

Resources & Role or Team Assignments
This selection determines which resource unit allocations are assigned and synchronized.
Meisterplan |
Jira |
|---|---|
|
|
|
-
Working with teams: Select the Jira field that corresponds to the team object in Meisterplan. Team names in Meisterplan and Jira must match.
If you work in an agile environment, we recommend planning at the team level in both Meisterplan and Jira – from rough to detailed planning within the team. In this case, prioritize teams to keep planning flexible, team-oriented, and close to actual delivery.
-
Working with roles: Roles in Meisterplan can be assigned to teams or a custom role field in Jira. The names in Meisterplan and Jira must match.
If you are planning in the traditional way, we recommend gradually converting roles to specific resources in Meisterplan. In Jira, detailed planning is done in the same way – from roles to specific assignees. In this scenario, the priority should be on assigning resources to ensure a consistent and controllable connection between planning and delivery.
- Working with resources: When enabled, Meisterplan resources are linked to the assignee field in Jira. The email addresses of the resources and Jira users must match.

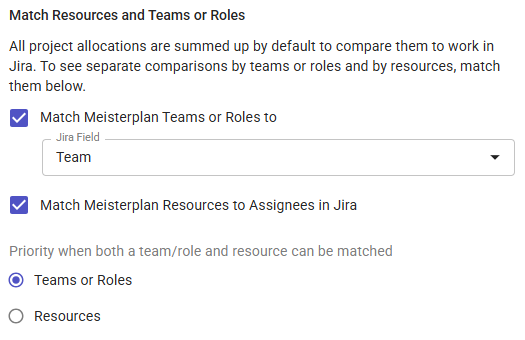

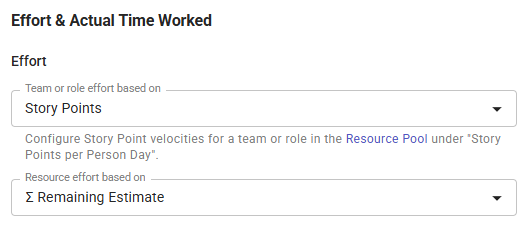

Effort Basis
This selection determines where the effort comes from in Jira and how it is converted, if necessary.
Meisterplan |
Jira |
|---|---|
|

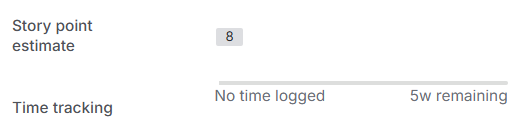

Please note: Story points cannot be used for resources. |

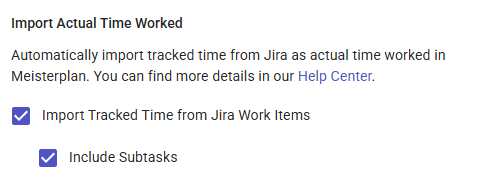

Actual Time Worked
Actual times are optional and can be transferred from Jira to Meisterplan or maintained directly in Meisterplan.
Meisterplan |
Jira |
|---|---|
|
If sub-tasks are included, time tracking will also be recorded for sub-tasks. Otherwise, Meisterplan assumes that time tracking takes place on the story.

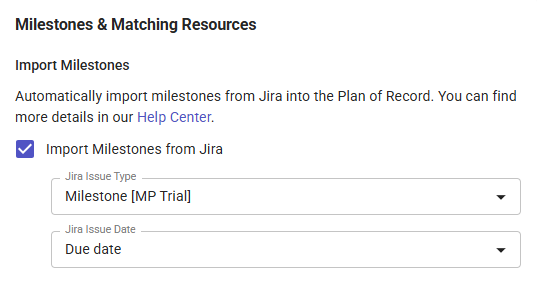

Milestones
Milestones are optional and can be transferred from Jira to Meisterplan or maintained directly in Meisterplan.
Milestones from Jira are only imported into the plan of record in Meisterplan.
Meisterplan |
Jira |
|---|---|
We recommend creating milestones in Jira across the entire company.
|
Automatic Data Synchronization
Automatic master data synchronization is currently possible via Jira Automation, Power Automate, or Zapier, as well as webhooks, which all utilize the Meisterplan Rest API.
Our in-house experts are happy to assist you with configuration.
3. Importing Epics directly from within the Meisterplan UI
Meet Prerequisites: Ensure you have the necessary user rights, such as "Import Data," and that a Jira link is configured in Meisterplan to establish the connection between the two systems.

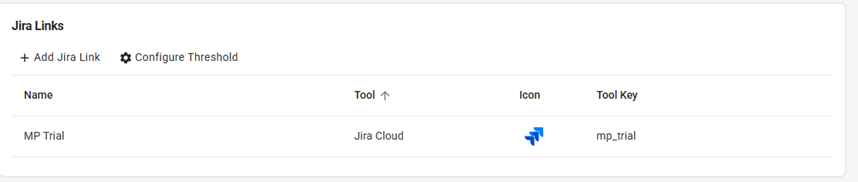

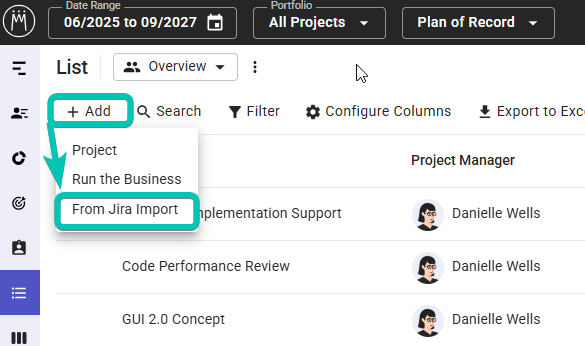

Start the Import: Select "Import from Jira" in the Meisterplan toolbar, and then choose the desired Jira link from the list to proceed.

Select Epics: You can choose the epics to be imported either from a filterable list or by entering a precise JQL query to select the specific Jira data you need.
Result: After the import, a new Meisterplan project is created for each epic. This allows you to visualize Jira tasks and efforts within your portfolio and compare them against your Meisterplan allocations.
Visit our Help Center for more details: Importing Jira Data as Meisterplan Projects.
4. Optional: Pushing Projects from Jira
If you currently start scoping projects within Jira, you can automatically push new project ideas you create in Jira to Meisterplan.
This is a description of how to set up a Jira automation rule that does this for you. When a Jira epic is created, a corresponding project in Meisterplan with a default length of 12 weeks will be generated. The Meisterplan project start date will match the epic creation date.
4.1 Precondition

Your Meisterplan system is connected to your Jira system via integration. An API-Token is created within Meisterplan.
4.2 How to Set Up the Automation

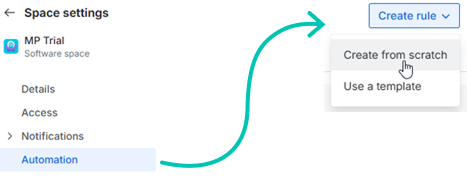

| In your Jira space, go to “Space Settings -> Automation” and click “Create Rule” -> ”Create from scratch”. |
|

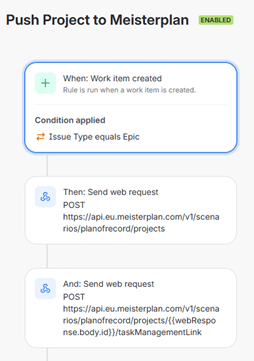

This is what the automation
|
|

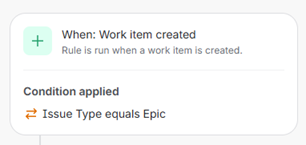

Step 1 Add the “When”-condition “Work item created”. |
Condition Settings This triggers the automation whenever an epic is created in Jira. |
|
|
Step 2
|

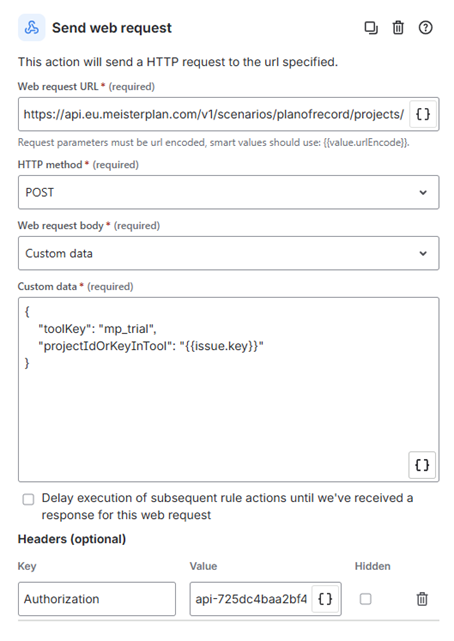

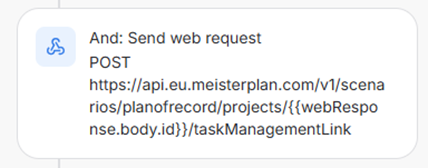

Action-Settings Web request URL: Meisterplan API-URL for creating projects in the Plan of Record. https://api.us.meisterplan.com/v1/scenarios (api.eu for European Meisterplan systems) Web request body: Select “Custom Data” to enter the data needed to create the project. “12” after “finish” defines the duration in weeks and can be adjusted.
“Delay execution” should be ticked to let the automation work properly. Headers: Value: The API token of your Meisterplan system. |
|
|
Step 3 Add the “Then”-action “Send web request” |

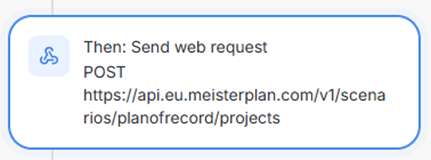

Action Settings Web request URL: https://api.us.meisterplan.com/v1/scenarios/ Web request body: Select “Custom Data” to enter the data needed to create the project.
“toolKey” is the name derived from the name of your Jira link in Meisterplan. Headers: Value: The API token of your Meisterplan system. |
|
|
Step 4 Enable the rule. Every new Jira epic will create a project in Meisterplan above the Cut-Off Line. |
The use of Jira automation is free, but the number of rule usage runs depends on the Jira plan and ranges from 100 to unlimited runs per month. See more here. |
